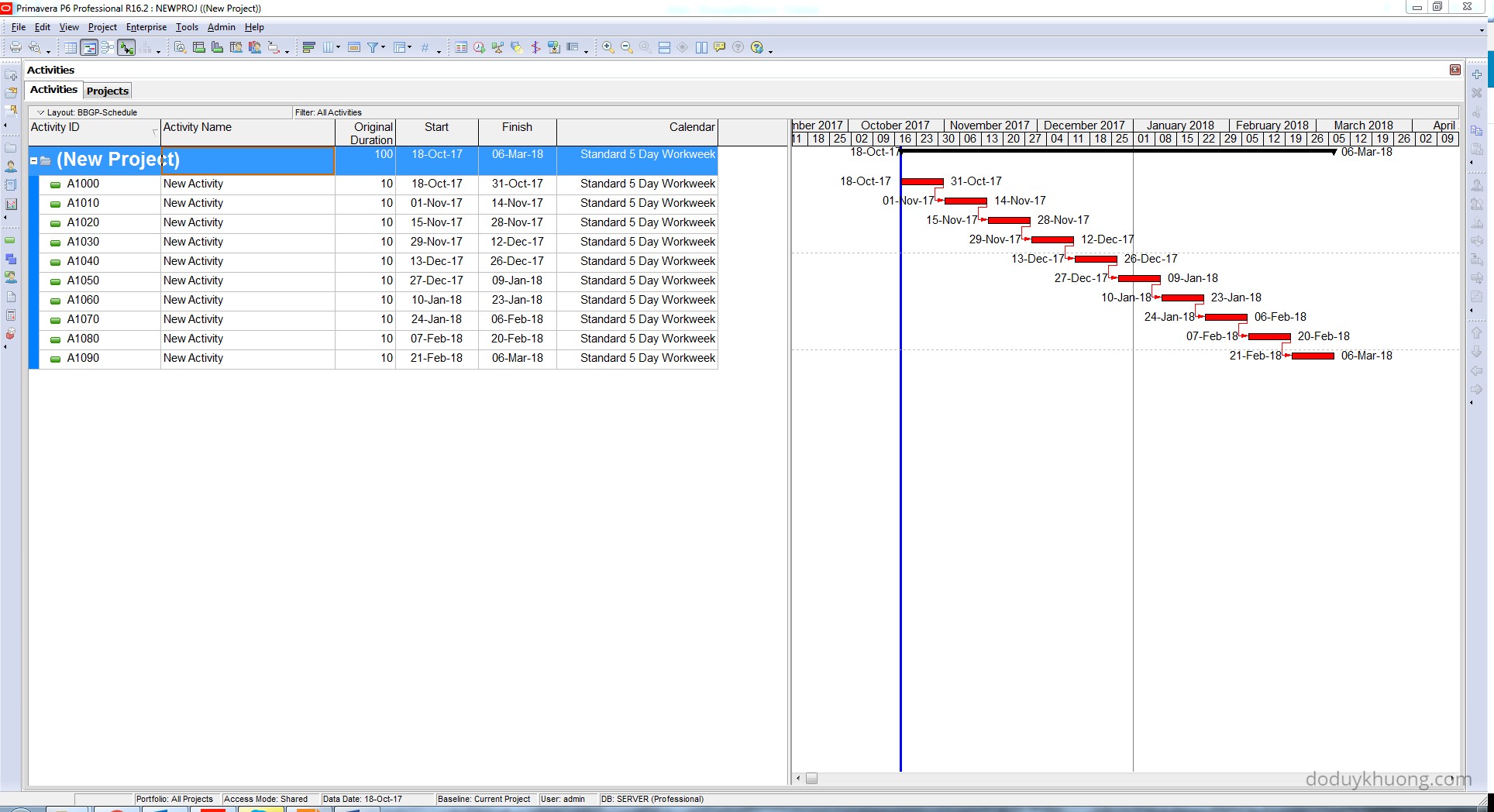

After three months of hard work, we completed a schedule using a 5-day workweek calendar, as shown in the image below.
Then came the twist.
The construction team said: “6 March 2018, is the correct project finish date—but we’re using a 7-day workweek, not a 5-day one. Sorry, must’ve been a misunderstanding.”
Wait, what?

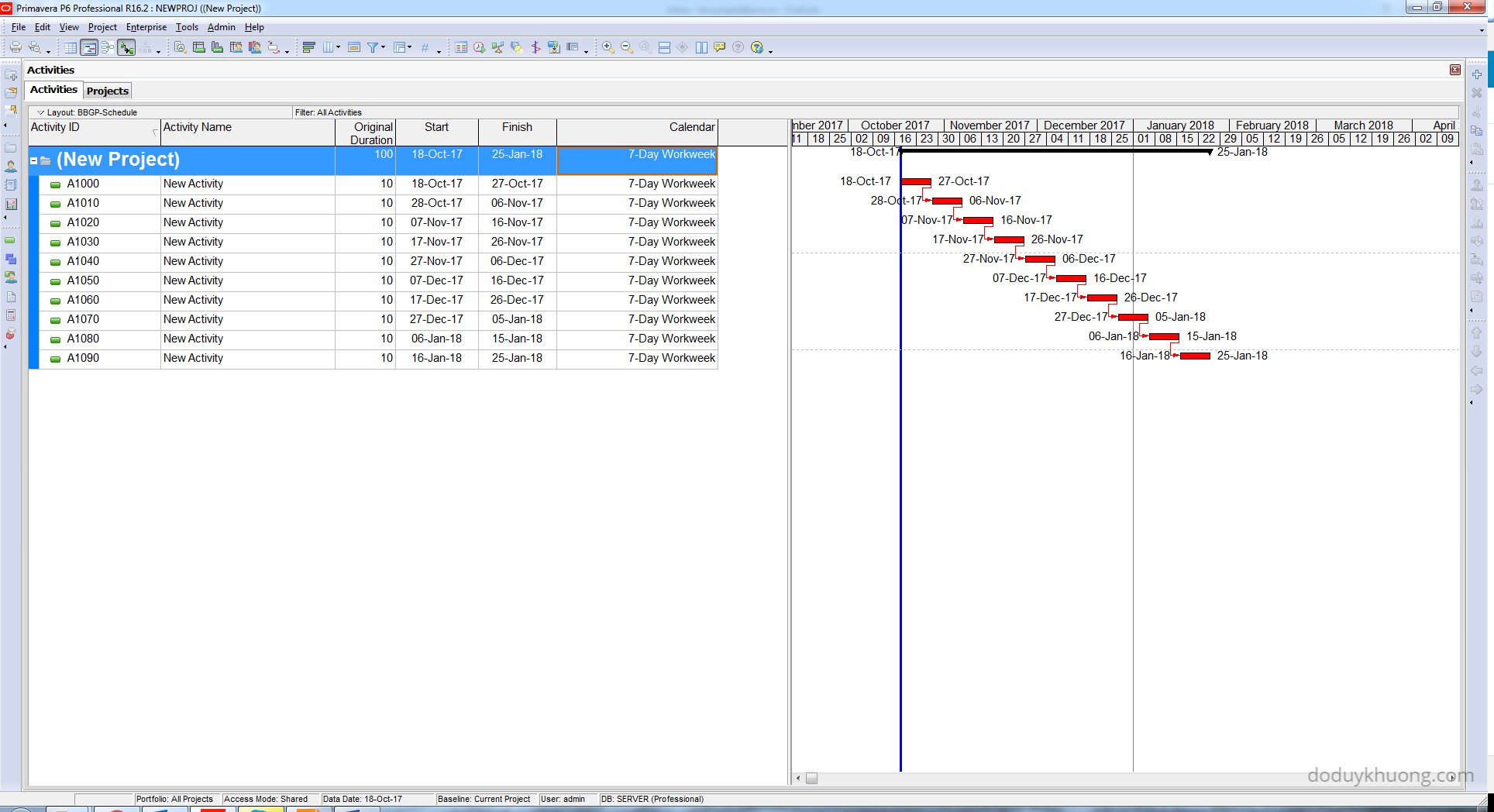

Changing the activity calendar affects everything. Normally, if you switch from a 5-day to a 7-day workweek, all activity finish dates shift, as shown in the next image. The new project finish date becomes January 25, 2018.
So how do we keep the original finish date of March 6, 2018, even after changing to a 7-day workweek?
Step 1: Create User Defined Fields
Go to Enterprise > User Defined Fields.

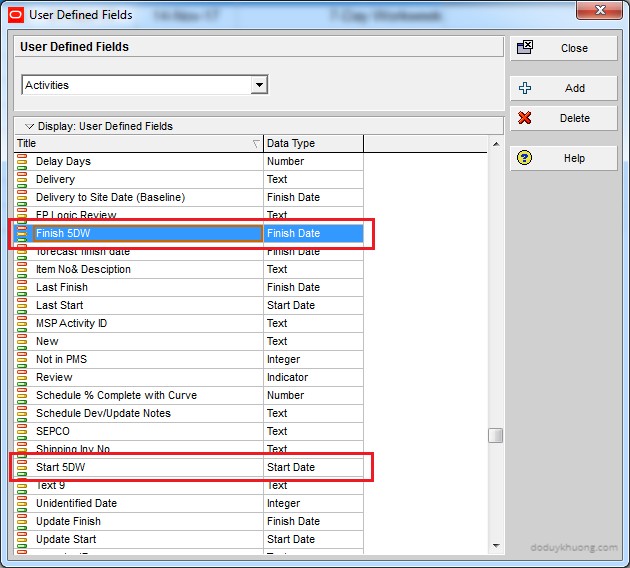

- Create a field called “Finish 5DW” with data type: Finish Date
- Create another field called “Start 5DW” with data type: Start Date
Step 2: Save Original Dates
Go to Tools > Global Change.
- Create a new change named “SaveTo5DW”

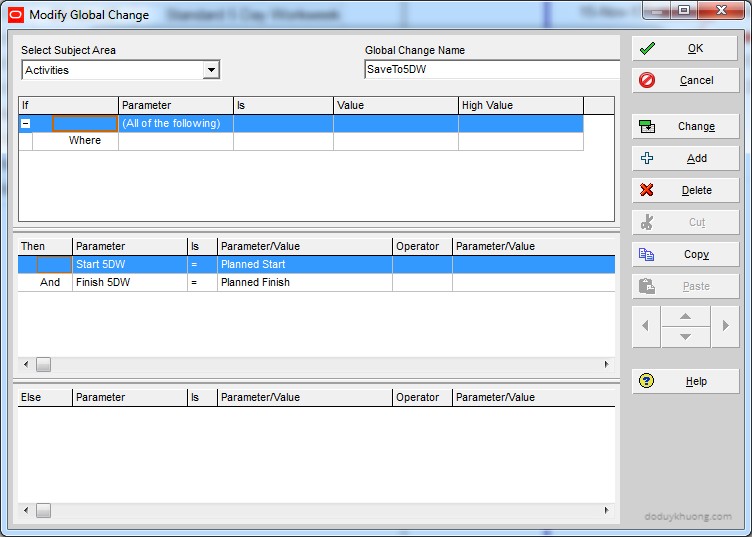

- Set it up to copy the current Start and Finish dates into the new UDFs: Start 5DW and Finish 5DW
- Click Change to apply
Step 3: Change the Calendar
Change the activity calendar to a 7-day workweek.
- You can update the first activity, then use the Fill Down function to apply it to the rest.
Step 4: Restore Original Dates
Go to Tools > Global Change again.
- Create a new change named “LoadFrom5DW”
- Set it up to copy values from Start 5DW and Finish 5DW back into the Start and Finish fields
- Click Change to apply
Now, all activity start and finish dates remain the same. Only the durations are recalculated based on the new 7-day calendar. The project finish date stays at March 6, 2018—just as required.
