How to assign resource / resource loading / make resource plan in Primavera P6

After creating your project schedule in Primavera P6, the next step is to assign resources to activities in order to develop a comprehensive resource plan.

In this guide, I’ll walk you through the process step-by-step.

Step 1: Prepare Your Schedule

Let’s assume you already have a schedule created, as shown in the image below:

how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-1

Step 2: Create Resources

Before assigning resources, you need to create them.

  1. Go to Enterprise → Resources.
  2. Click the Plus (+) icon to add a new resource.

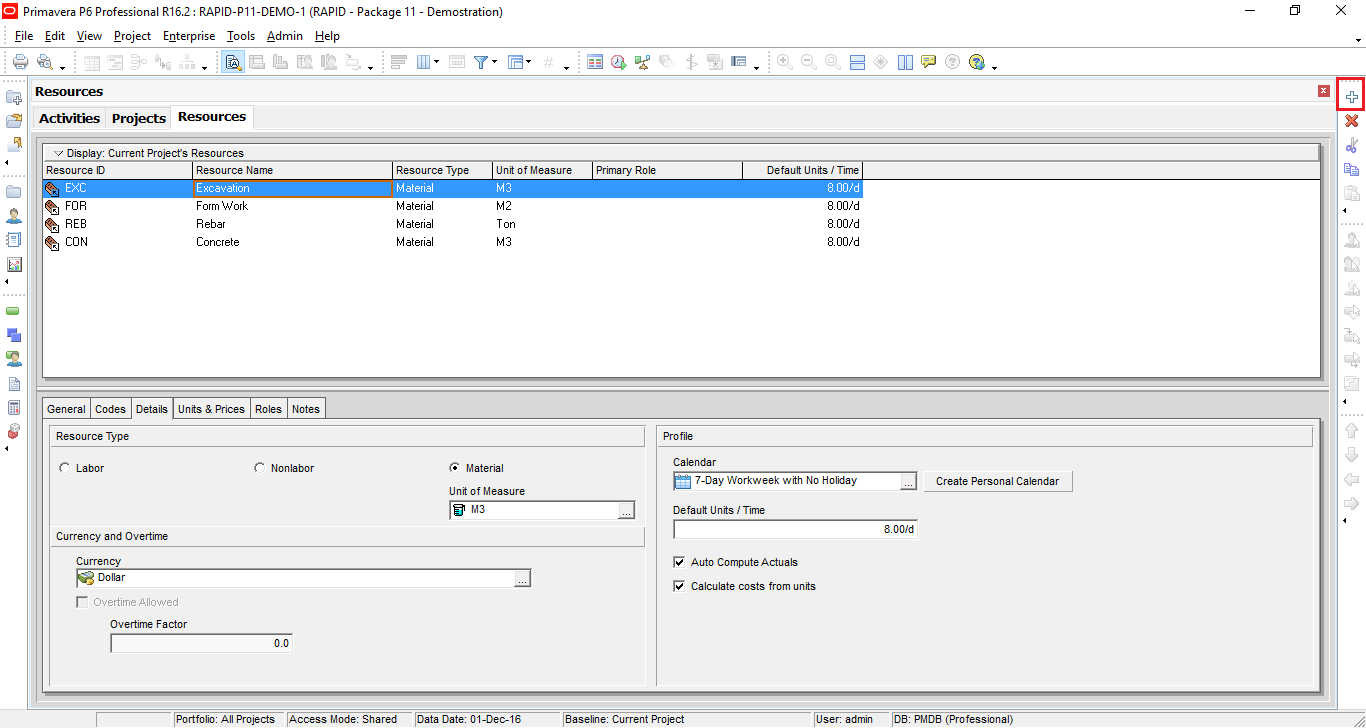

how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-2

In this example, I’ve created four Material-type resources.

Set Unit of Measure

If the unit of measure you need isn’t available:

  1. Go to Admin → Admin Categories.
  2. Navigate to the Units of Measure tab.
  3. Click Add to create a new unit.



how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-3

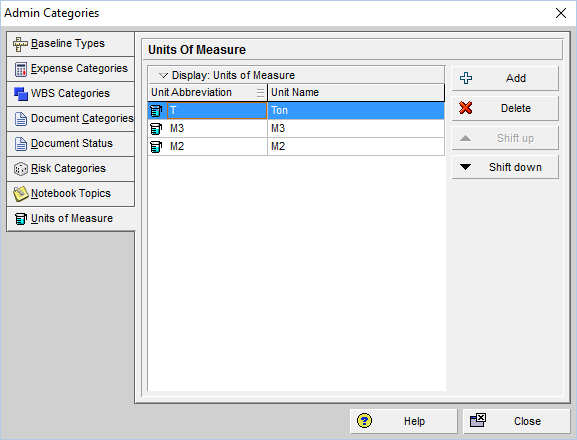

how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-4

Step 3: Assign Resources to Activities

  1. Go to Project → Activities.
  2. Select the activity you want to assign resources to.
  3. Open the Resources tab and click Add Resource.

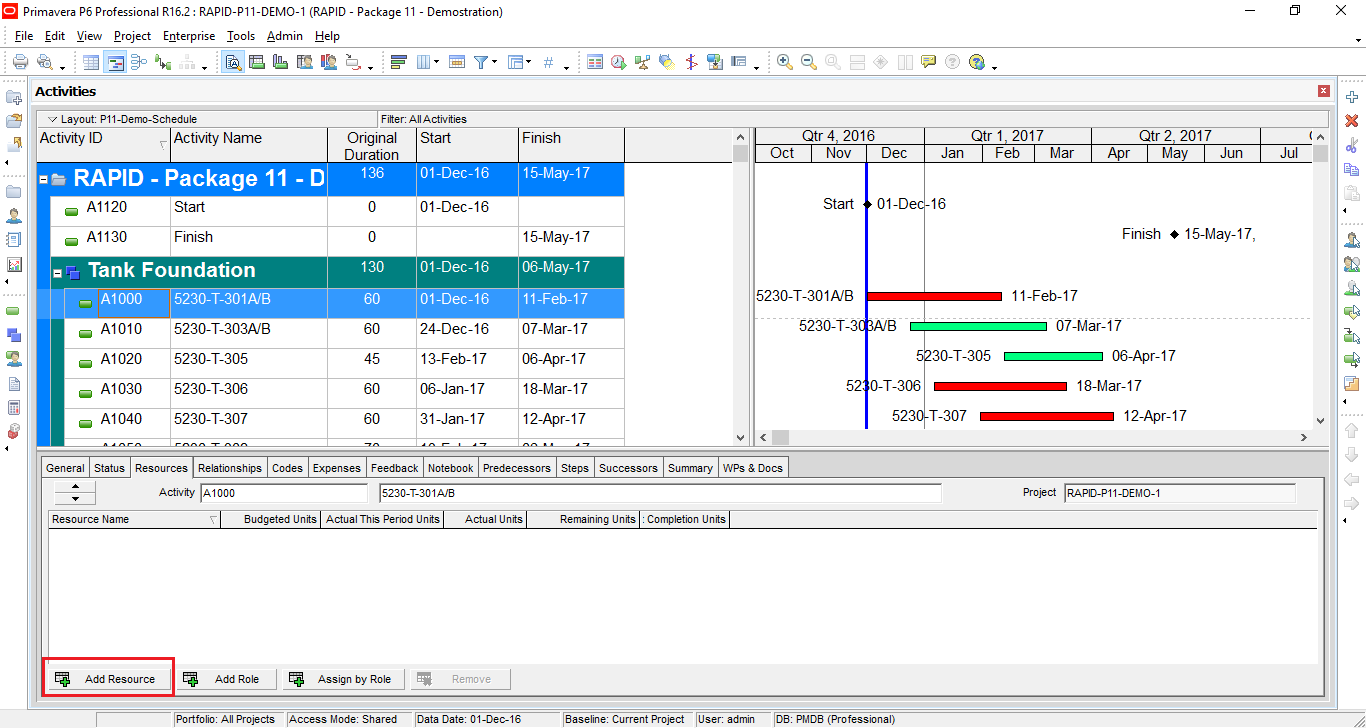

how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-5

  1. Click Display → Filter By → All Active Resources to view your list.
  2. Select the desired resources and click Assign.

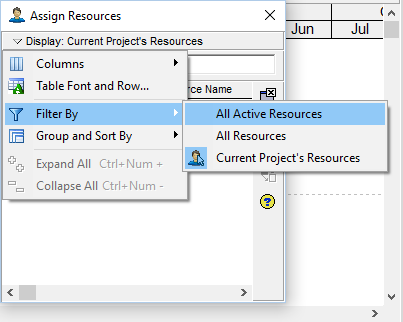

how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-6

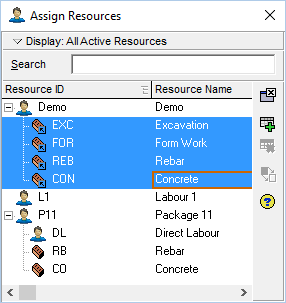

how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-7

  1. In the Budgeted Units column, enter the required quantity.



how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-8

By default, Primavera distributes the resource usage linearly. For example, assigning 80 m³ over a 10-day activity results in 8 m³ per day.

Step 4: Customize Resource Distribution (Optional)

If you prefer a non-linear distribution:

  1. Right-click in the Resources tab and select Customize Resource Columns.
  2. Add the Curve column.

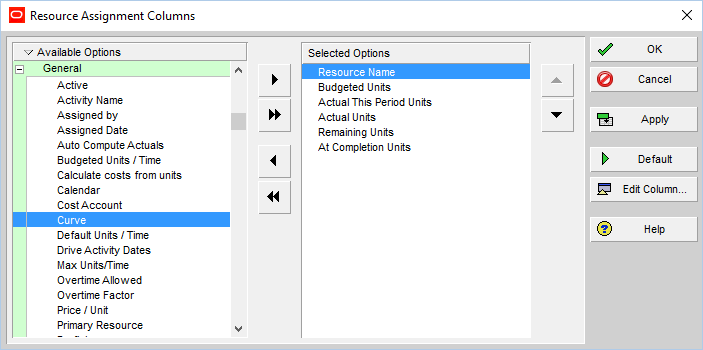

How to assign resource, resource loading, make resource plan in Primavera P6-18



How to assign resource, resource loading, make resource plan in Primavera P6-19

  1. In the Curve column, choose a distribution type (e.g., Back Loaded).

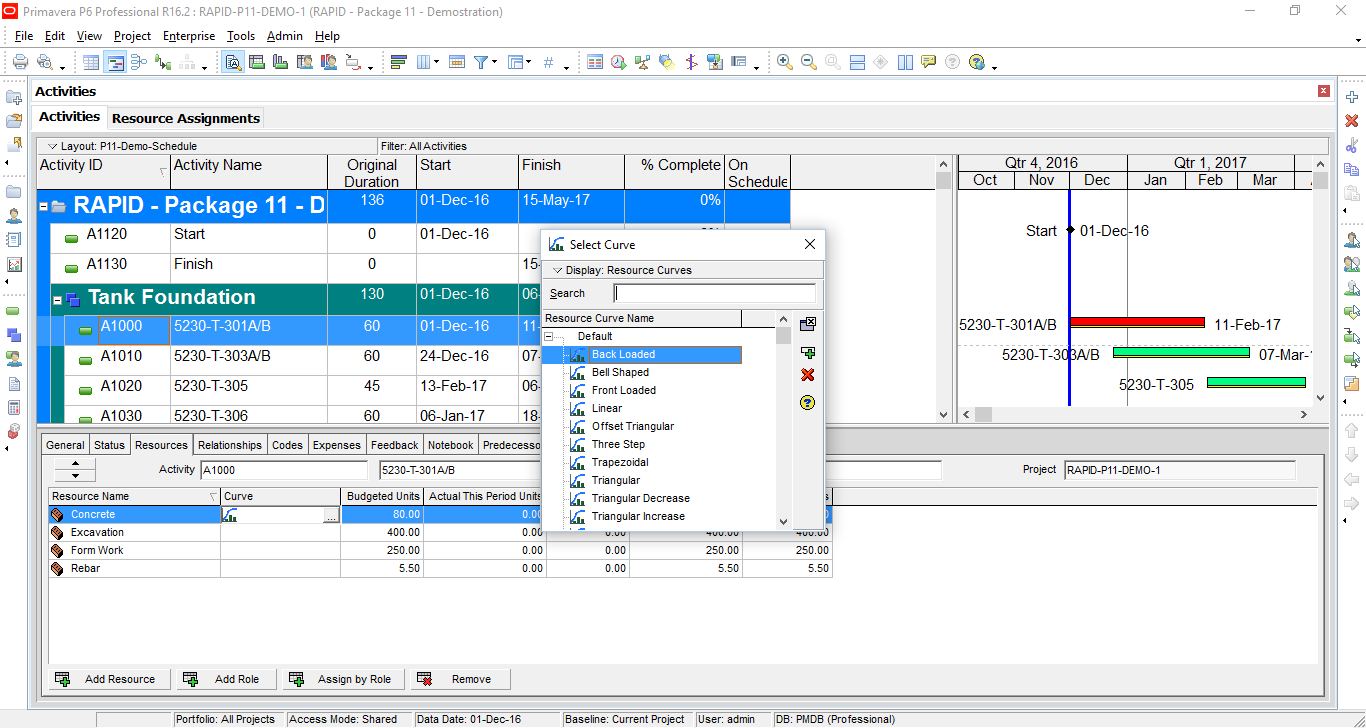

How to assign resource, resource loading, make resource plan in Primavera P6-20

Now, the resource is distributed more heavily toward the end of the activity:



How to assign resource, resource loading, make resource plan in Primavera P6-21

Step 5: Review Resource Assignments

  1. Go to Project → Resource Assignments.
  2. Customize the layout to view your resource plan clearly.



how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-9

(You can download the Primavera layout here)

You can now easily view the Quantity Plan:

how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-10

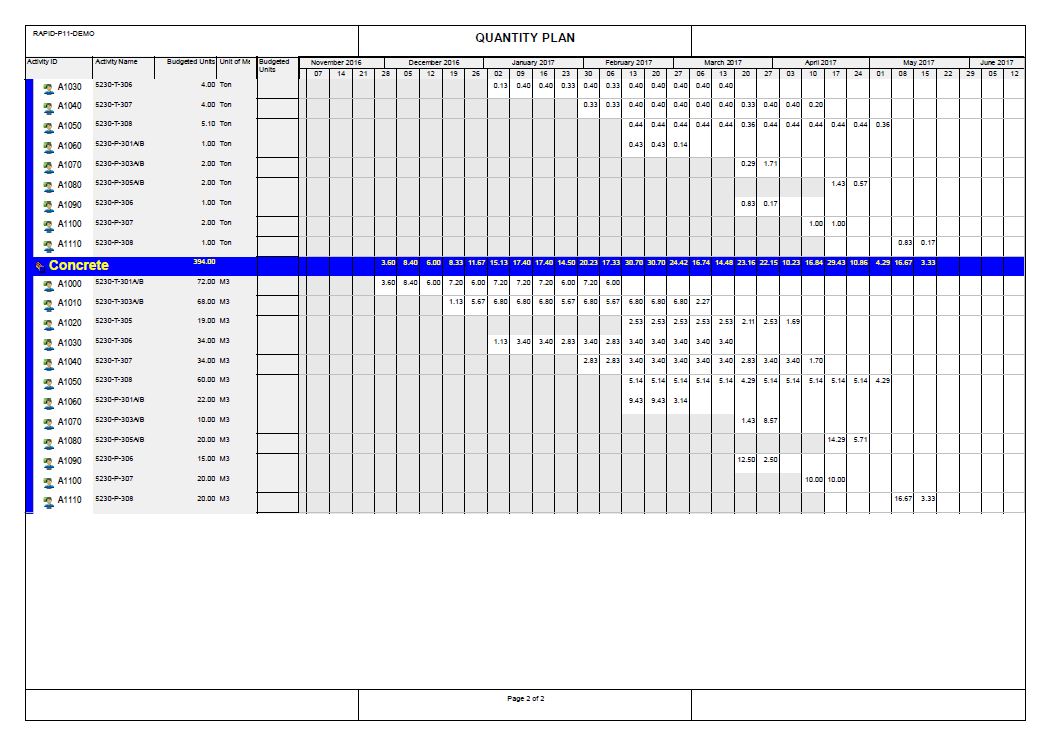

how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-11

Step 6: Generate a Concrete Plan Chart

  1. In the Activities window, open the Resource Usage Profile.
  2. Select the Concrete resource.
  3. Right-click on the chart area and choose Resource Usage Profile Options.

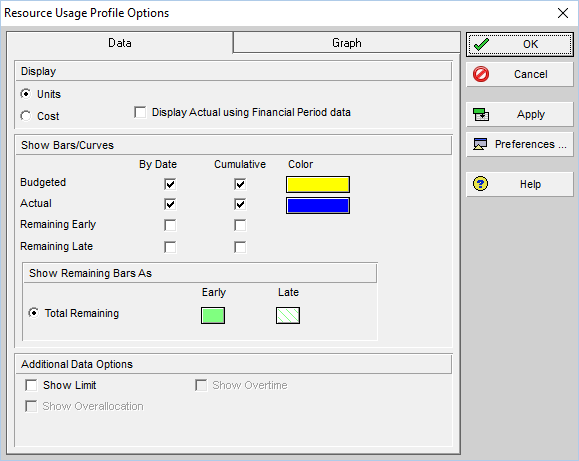

  4. Adjust the settings as shown in the picture below:



how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-12



how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-13



how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-14

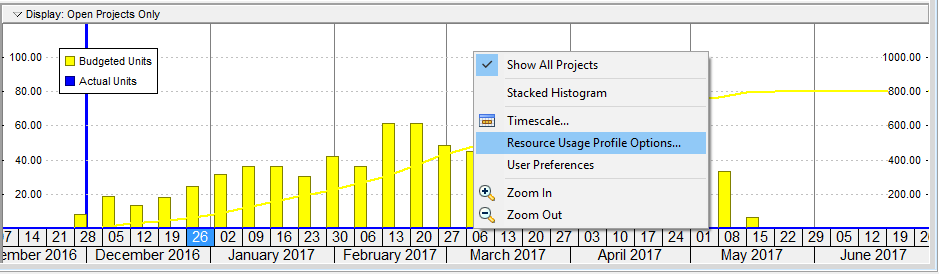

You’ll now see a chart like this:

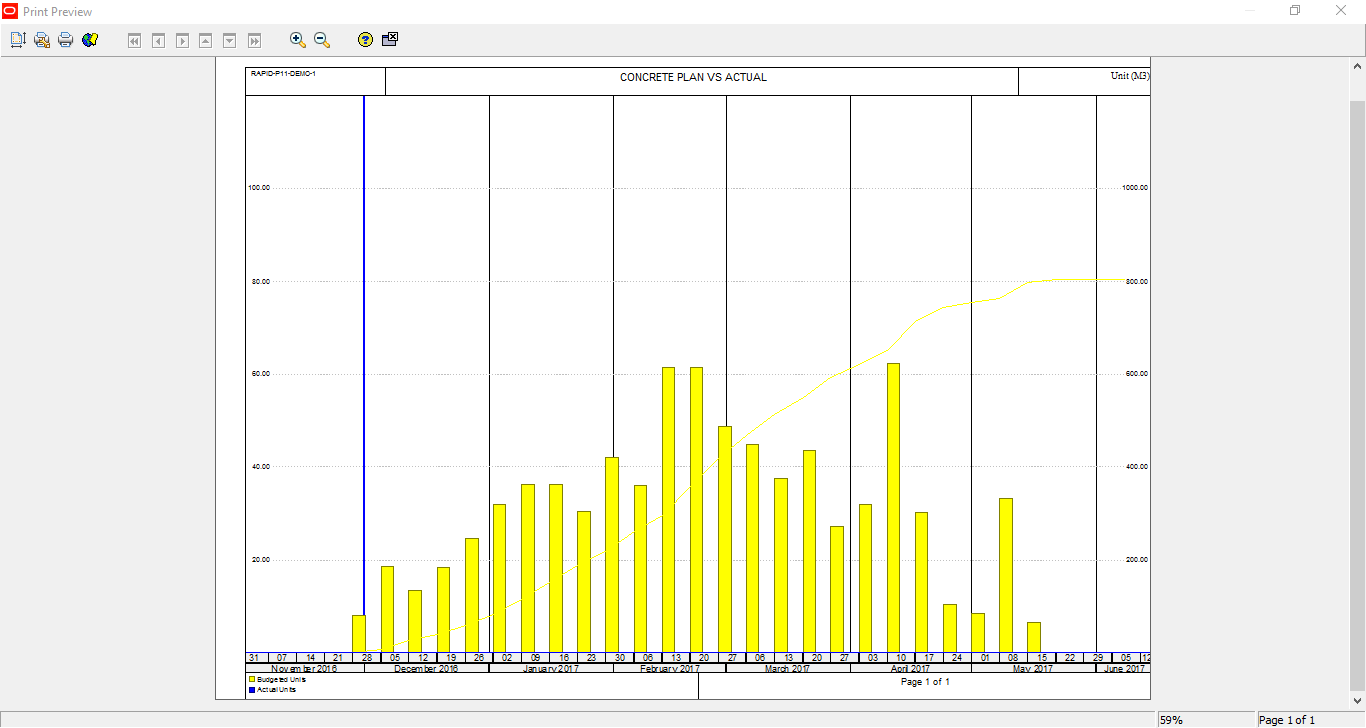

how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-15

(You can download the Primavera layout here)

Later, when you update the project with actual progress, the report will reflect the updated data:

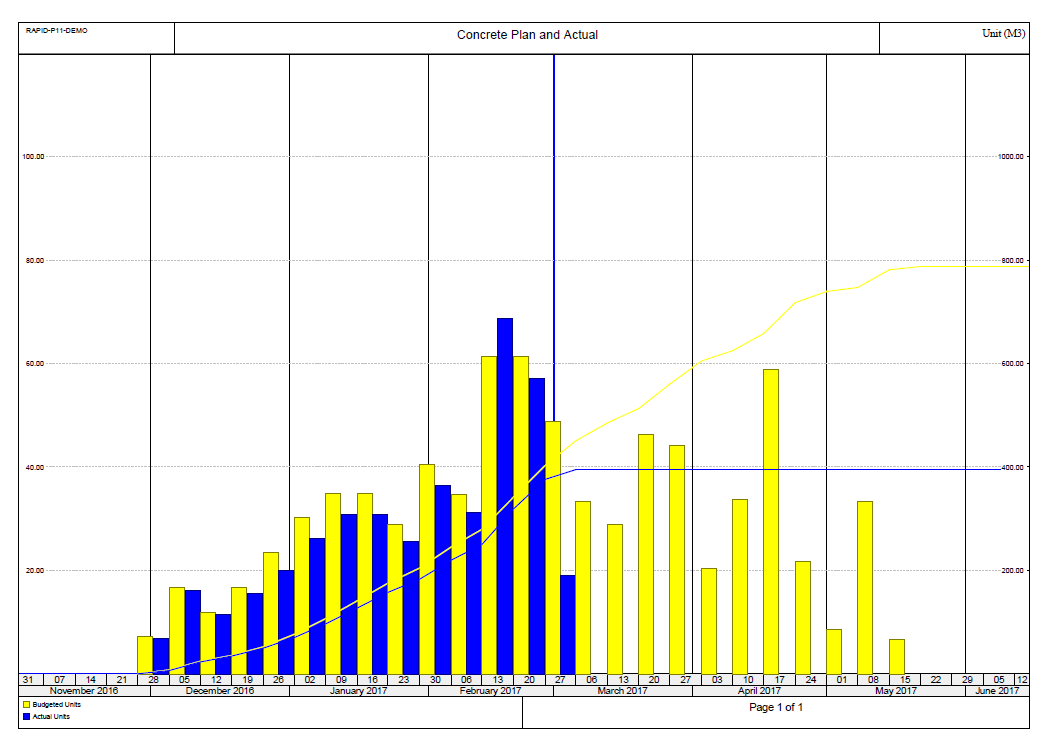

how-to-assign-resource-resource-loading-make-resource-plan-in-primavera-p6-16
