How to highlight a Time period in Gantt chart in Microsoft Project

Microsoft Project does not offer a built-in tool to directly highlight a specific time period in the Gantt chart. However, you can achieve this effect by using a custom calendar. Here’s how:

Create a New Calendar

    • Go to the Project tab and select Change Working Time.
    • Click Create New Calendar and name it something like “Gantt Shade”.

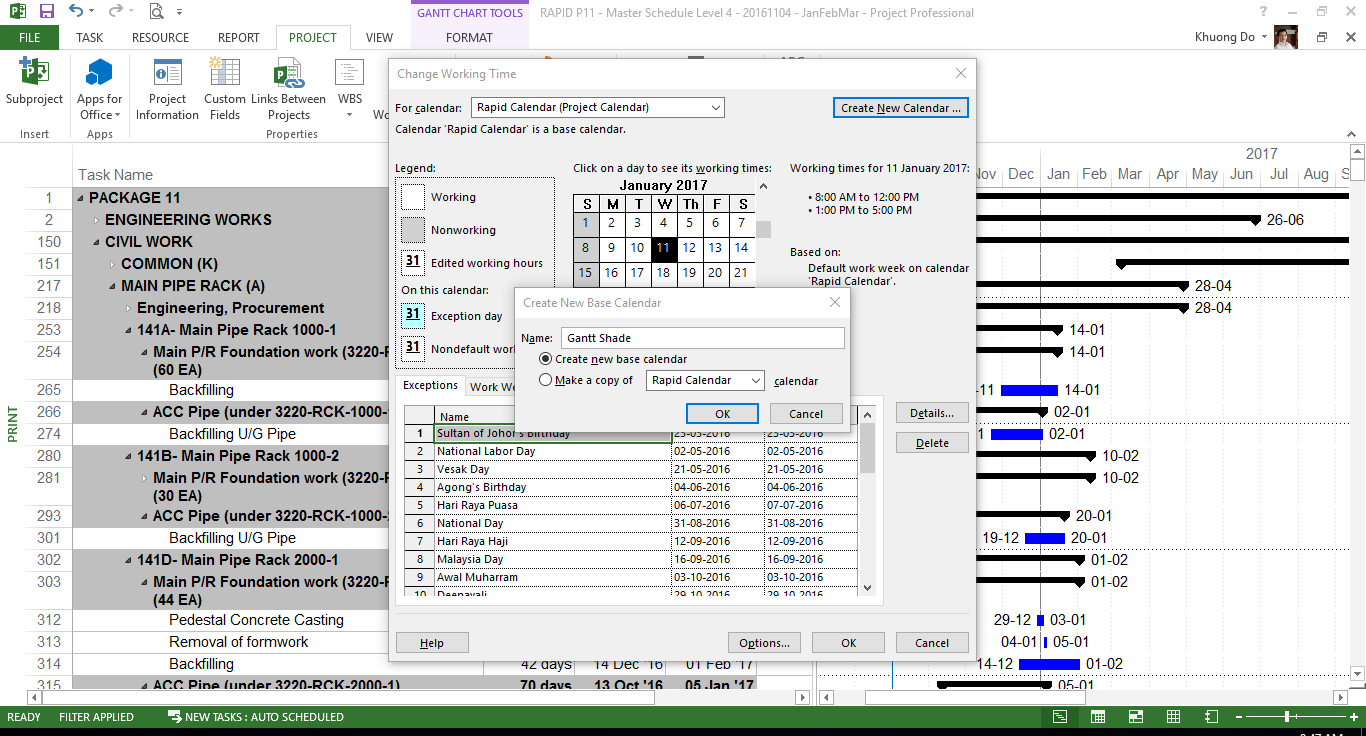

how-to-highlight-a-time-period-in-gantt-chart-in-microsoft-project-1

Define the Highlighted Time Period

  • In the Exceptions tab of the new calendar, add a new exception for the time period you want to highlight (e.g., January to March).
  • Set the Start and Finish dates accordingly.

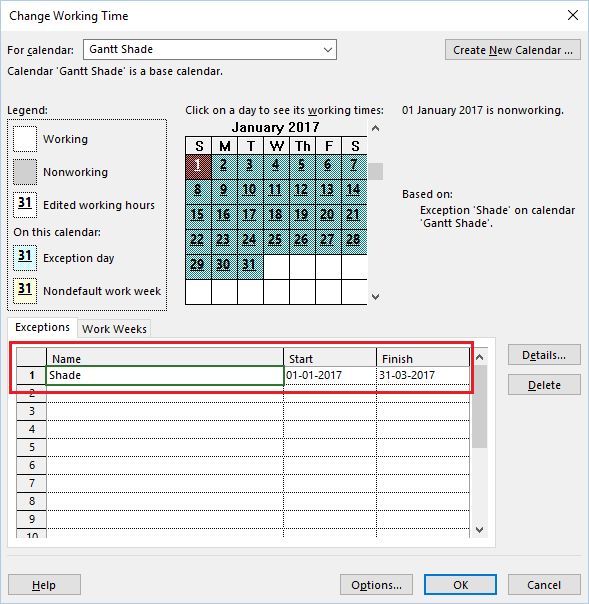

how-to-highlight-a-time-period-in-gantt-chart-in-microsoft-project-2

Apply the Calendar to the Gantt Chart

  • Right-click anywhere on the Gantt chart and select Nonworking Time….

how-to-highlight-a-time-period-in-gantt-chart-in-microsoft-project-3

  • In the Non-working Time tab:
    • Set Calendar to Gantt Shade.
    • Set Draw to Behind task bars.
    • Choose a Color (e.g., Gray) to visually distinguish the time period.

how-to-highlight-a-time-period-in-gantt-chart-in-microsoft-project-4

Result

  • The selected time period (e.g., January to March) will now appear shaded in the background of your Gantt chart.

how-to-highlight-a-time-period-in-gantt-chart-in-microsoft-project-5
