How to define Resource Productivity in Primavera P6 and create schedule

When building a schedule in Primavera P6, you can estimate activity durations based on resource productivity. Here’s a step-by-step guide using a concrete example.

Example Scenario

  • A construction team can cast 10 m³ of concrete per day (this is the productivity).
  • A foundation requires 100 m³ of concrete.
  • Therefore, the activity duration is calculated as:

Now, let’s implement this in Primavera P6 using an example project illustrated in the picture below:

How to define Productivity in Primavera P6 and create schedule-1

Step-by-Step Instructions

1. Set Duration Type

  • Open your project.
  • Change the Duration Type of all relevant activities to “Fixed Units/Time”.
    This ensures that duration is calculated based on resource productivity.

How to define Productivity in Primavera P6 and create schedule-2

2. Create a Resource

  • Go to Enterprise → Resources.
  • Create a new resource named Concrete.

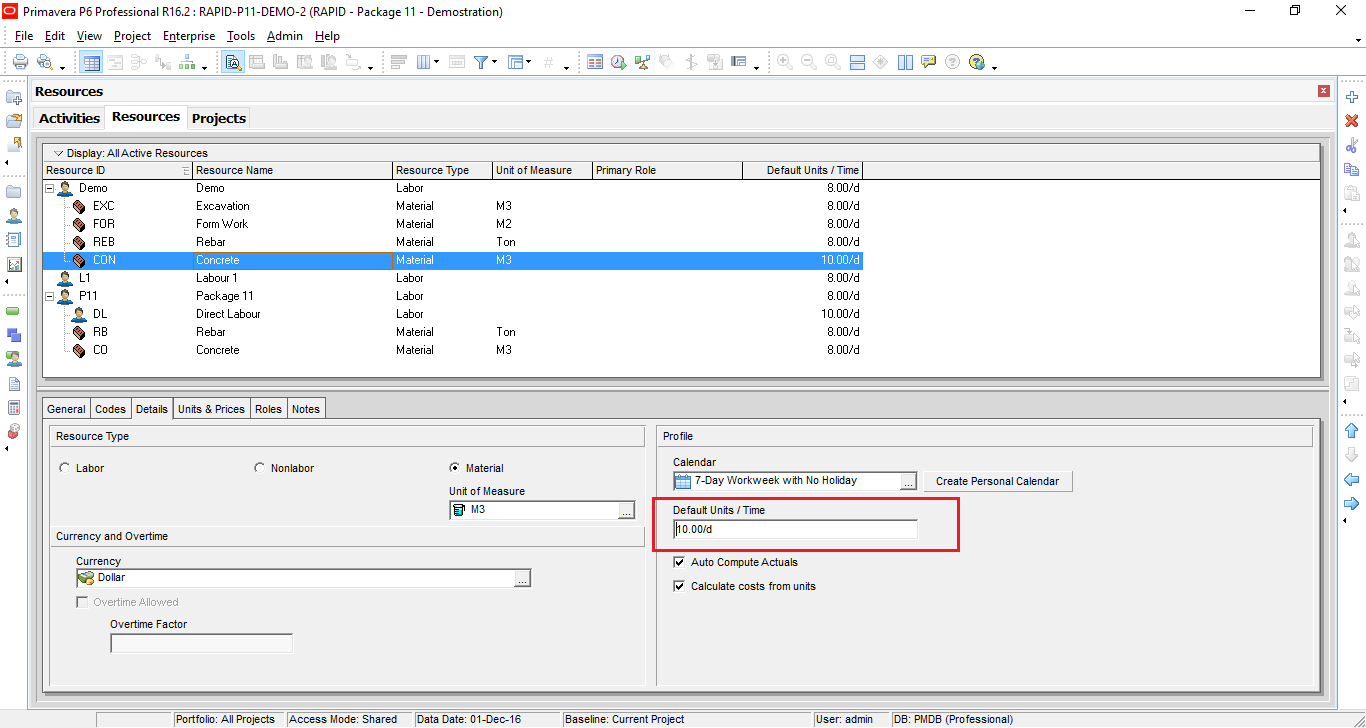

  • In the Details tab, under Default Units/Time, enter 10 (representing 10 m³/day).

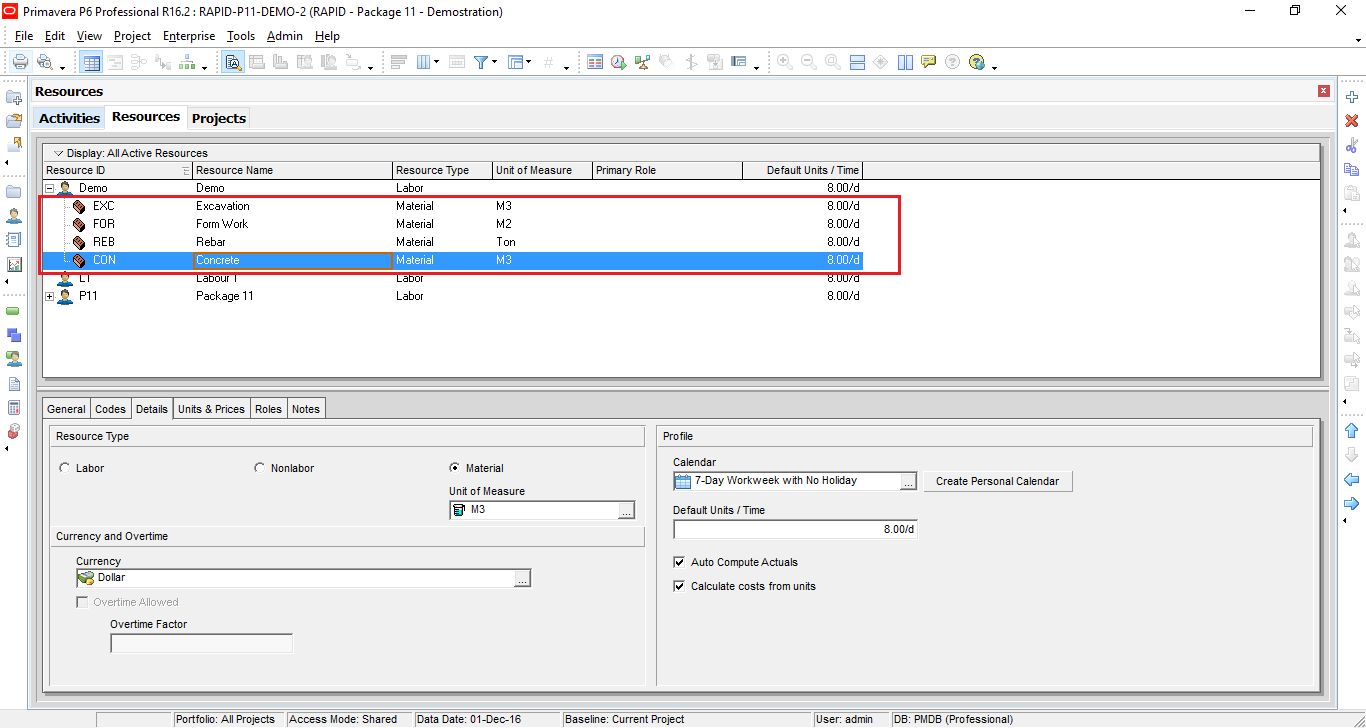

How to define Productivity in Primavera P6 and create schedule-3



How to define Productivity in Primavera P6 and create schedule-4

3. Assign the Resource

  • Go to Project → Activities.
  • Assign the Concrete resource to the foundation activity.

How to define Productivity in Primavera P6 and create schedule-5

How to define Productivity in Primavera P6 and create schedule-6

4. Set Budgeted Units

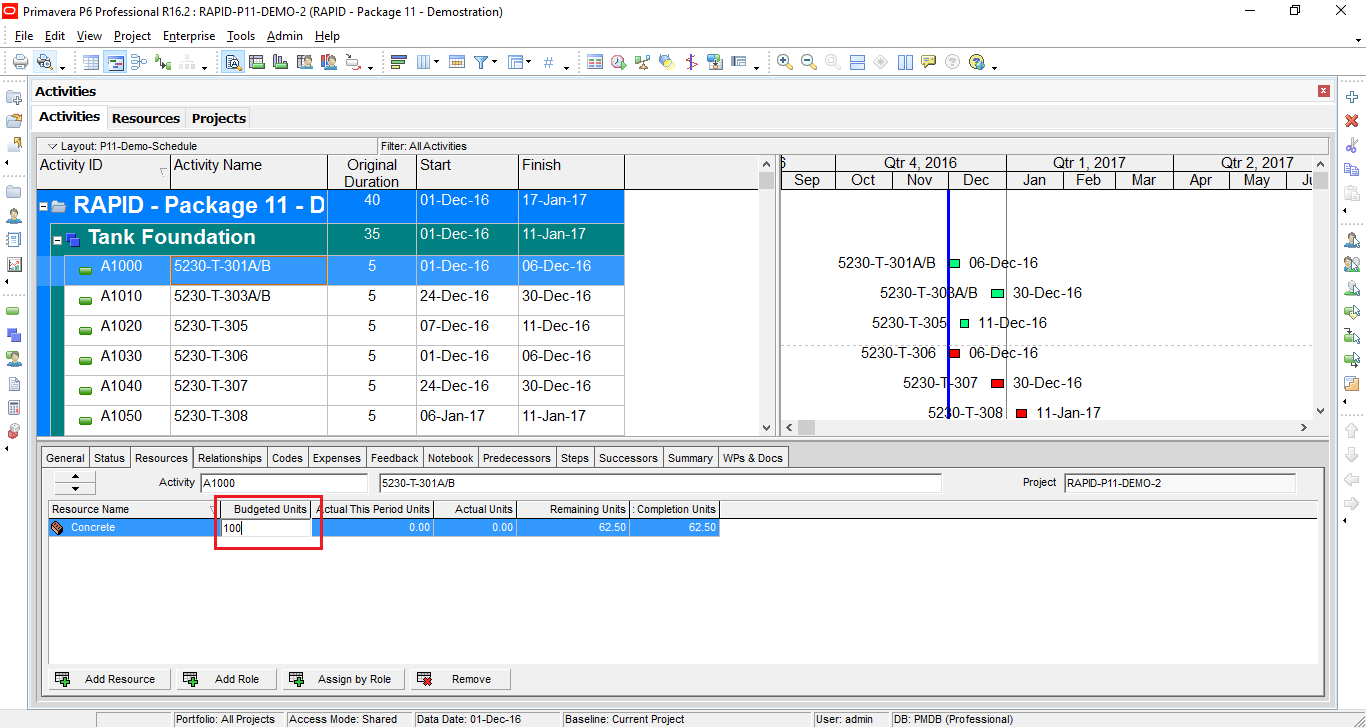

  • In the activity details, set Budgeted Units to 100 (for 100 m³ of concrete).
  • Primavera will automatically calculate the duration as 10 days.

How to define Productivity in Primavera P6 and create schedule-7



How to define Productivity in Primavera P6 and create schedule-8

5. Repeat for Other Activities

  • Use the same method to define productivity and duration for other resource-driven activities.



Handling Multiple Resources

If an activity has multiple resources, the finish date will be determined by the latest finish date among them.

Example:

  • Add another resource: Backfill.
  • Set its Budgeted Units to 1000.

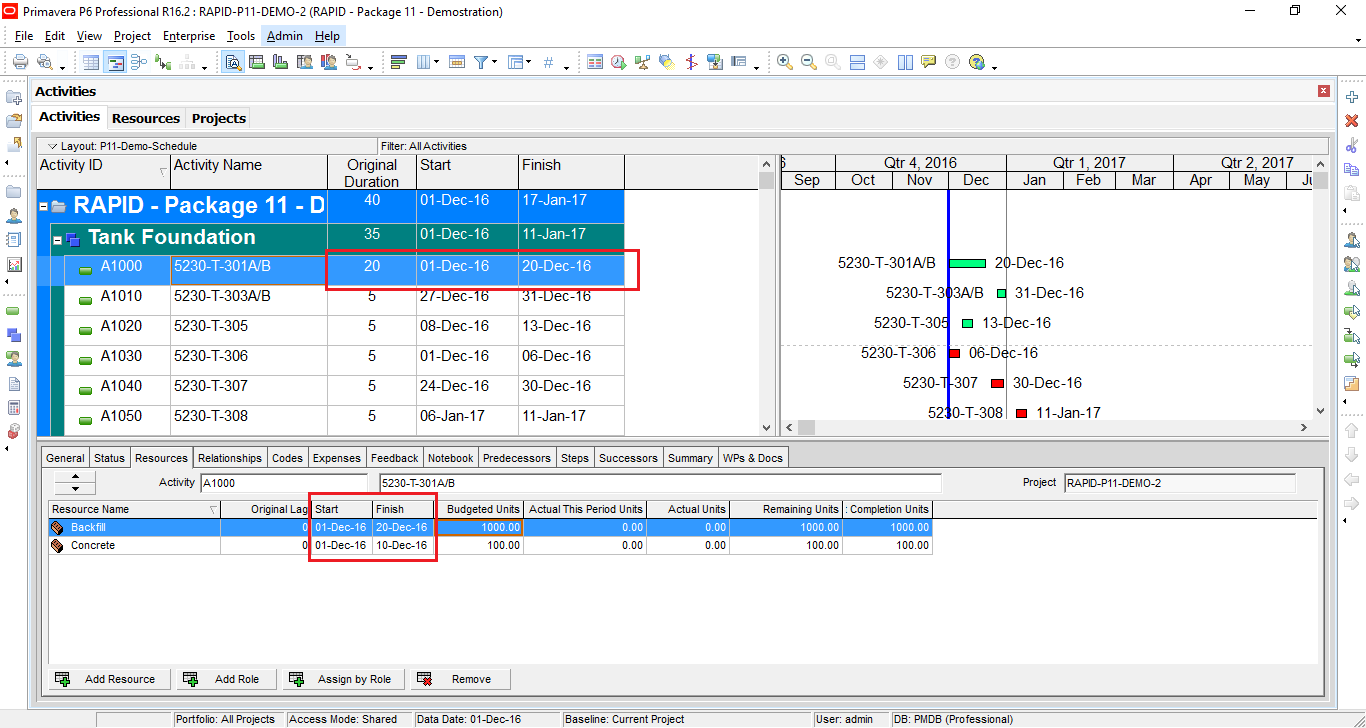

  • If Backfill finishes on 20-Dec-16, and Concrete finishes on 10-Dec-16, the activity will finish on 20-Dec-16.

How to define Productivity in Primavera P6 and create schedule-9



How to define Productivity in Primavera P6 and create schedule-10

Adjusting Start Dates

  • If Backfill should start after Concrete, add a lag.
  • Enter 12 days in the Original Lag column.
  • Backfill will now start on 13-Dec-16, creating a more realistic schedule.
