What is the difference between Activity type: Task Dependent and Resource Dependent in Primavera P6

In Primavera P6, there are two commonly used activity types: Task Dependent and Resource Dependent. The key difference between them lies in how the software determines the calendar used to calculate the activity’s finish date.

  • Task Dependent: P6 uses the Activity Calendar to calculate the finish date.
  • Resource Dependent: P6 uses the Resource Calendar to calculate the finish date.

This choice directly impacts the Original Duration and Finish Date of the activity.

Let’s explore this with an example.

  • Activity A has a working duration of 10 days.
  • The Activity Calendar is set to 7 days/week.
What is the difference between Activity type Task Dependent and Resource Dependent in Primavera P6-1
  • The activity is assigned to Resource R, who works 5 days/week.
What is the difference between Activity type Task Dependent and Resource Dependent in Primavera P6-2

What is the difference between Activity type Task Dependent and Resource Dependent in Primavera P6-3

Scenario 1: Task Dependent

  • P6 uses the Activity Calendar (7 days/week).
  • The activity duration remains 10 calendar days.
  • The Finish Date is calculated as 24-Mar-18.

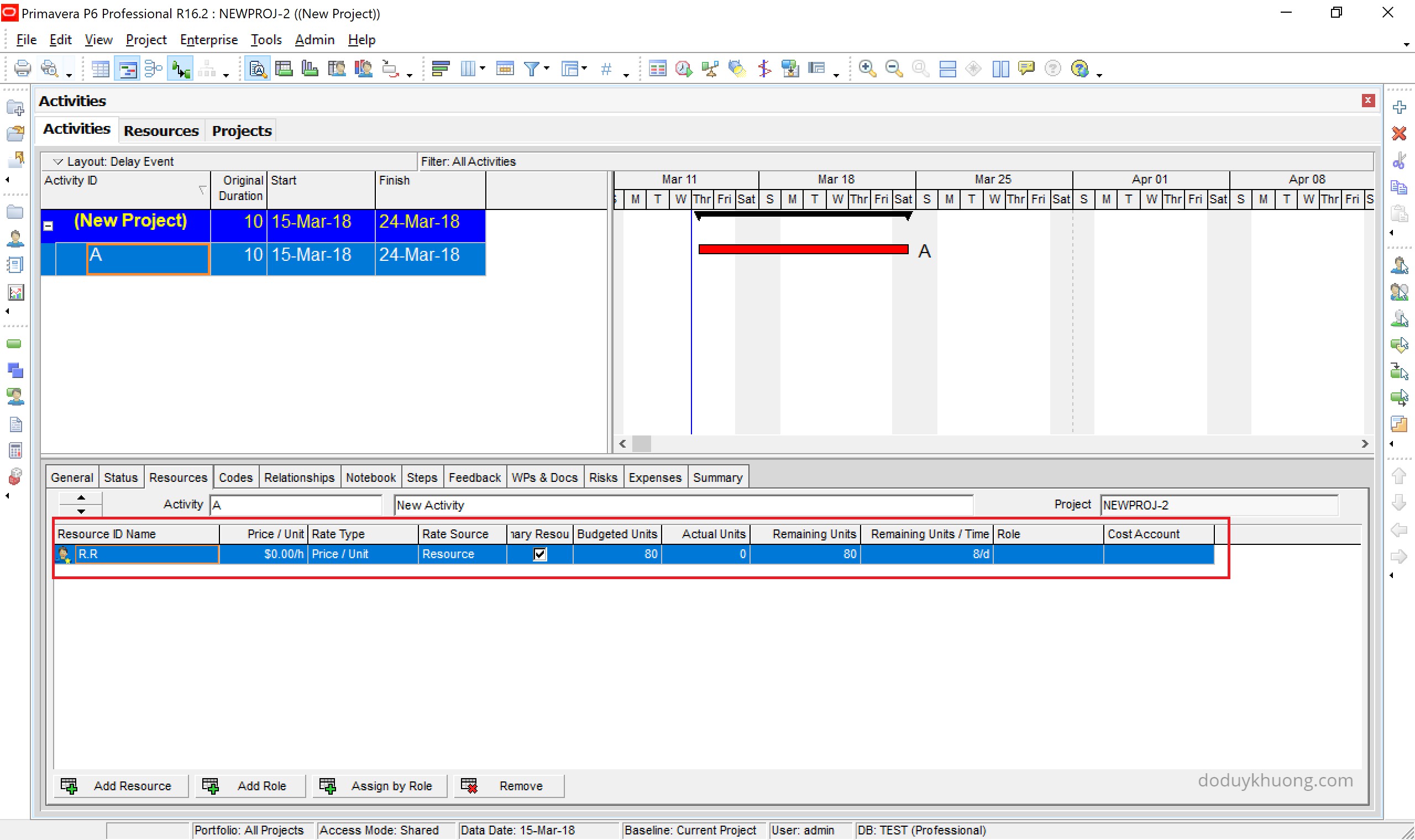

What is the difference between Activity type Task Dependent and Resource Dependent in Primavera P6-4
When choosing Task Dependent, the Finish Date of activity is 24-Mar-18

Scenario 2: Resource Dependent

  • P6 uses the Resource Calendar (5 days/week).
  • The activity duration is extended to 14 calendar days.
  • The Finish Date becomes 28-Mar-18.
What is the difference between Activity type Task Dependent and Resource Dependent in Primavera P6-5
When choosing Resource Dependent, the Finish Date of activity is 28-Mar-18

How P6 Calculates Duration for Resource Dependent Activities

  1. When a resource is assigned, P6 initially copies the 10-day duration from the activity to the resource.
  2. Using the 5-day workweek of the resource, P6 calculates the Resource Finish Date.

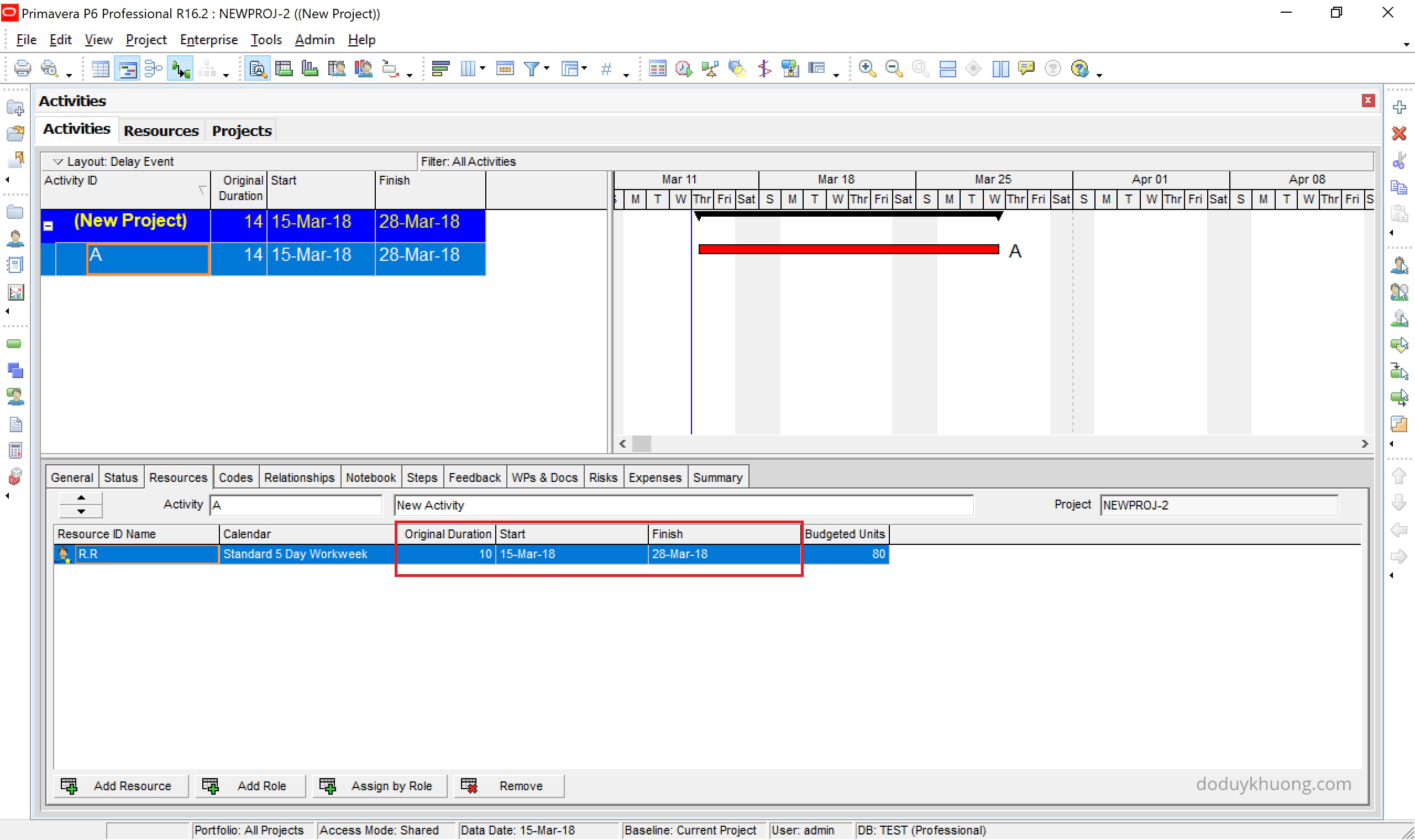

What is the difference between Activity type Task Dependent and Resource Dependent in Primavera P6-6

3. This Resource Finish Date is then mirrored to the Activity Finish Date.

4. Finally, P6 uses the 7-day workweek of the activity calendar to recalculate the Activity Duration, resulting in 14 calendar days.

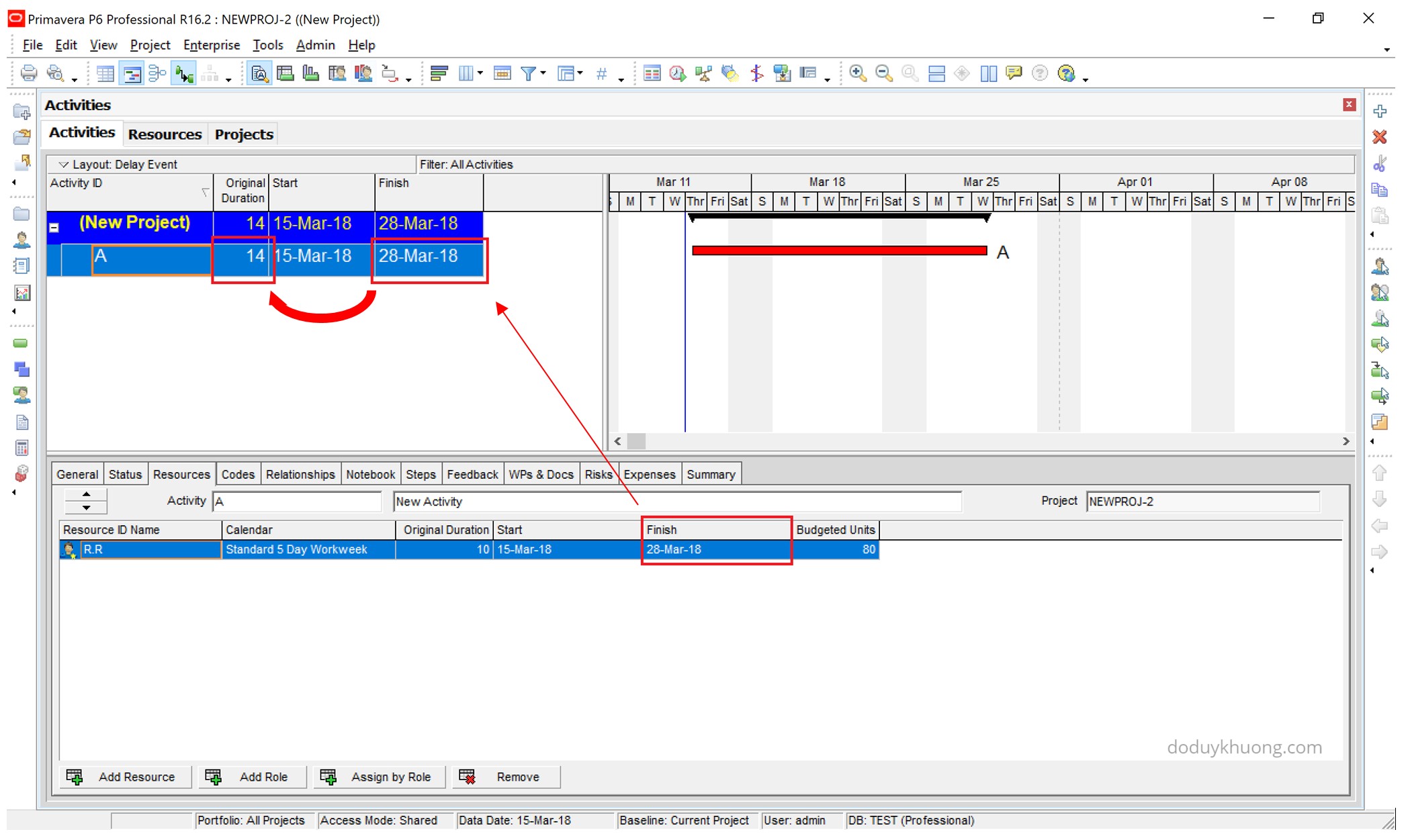

    What is the difference between Activity type Task Dependent and Resource Dependent in Primavera P6-8
    P6 uses 7 days workweek of the activity to calculate Activity Duration
