How to use Activity Duration Type in Primavera P6

When assigning a resource to an activity in Primavera P6, the following equation always holds true:

Original Duration × Units/Time = Total Units

For example:
10 days × 8 hours/day = 80 hours

This equation is fundamental and must always remain valid, regardless of changes made to the activity.

How to use Activity Duration Type in Primavera P6-6

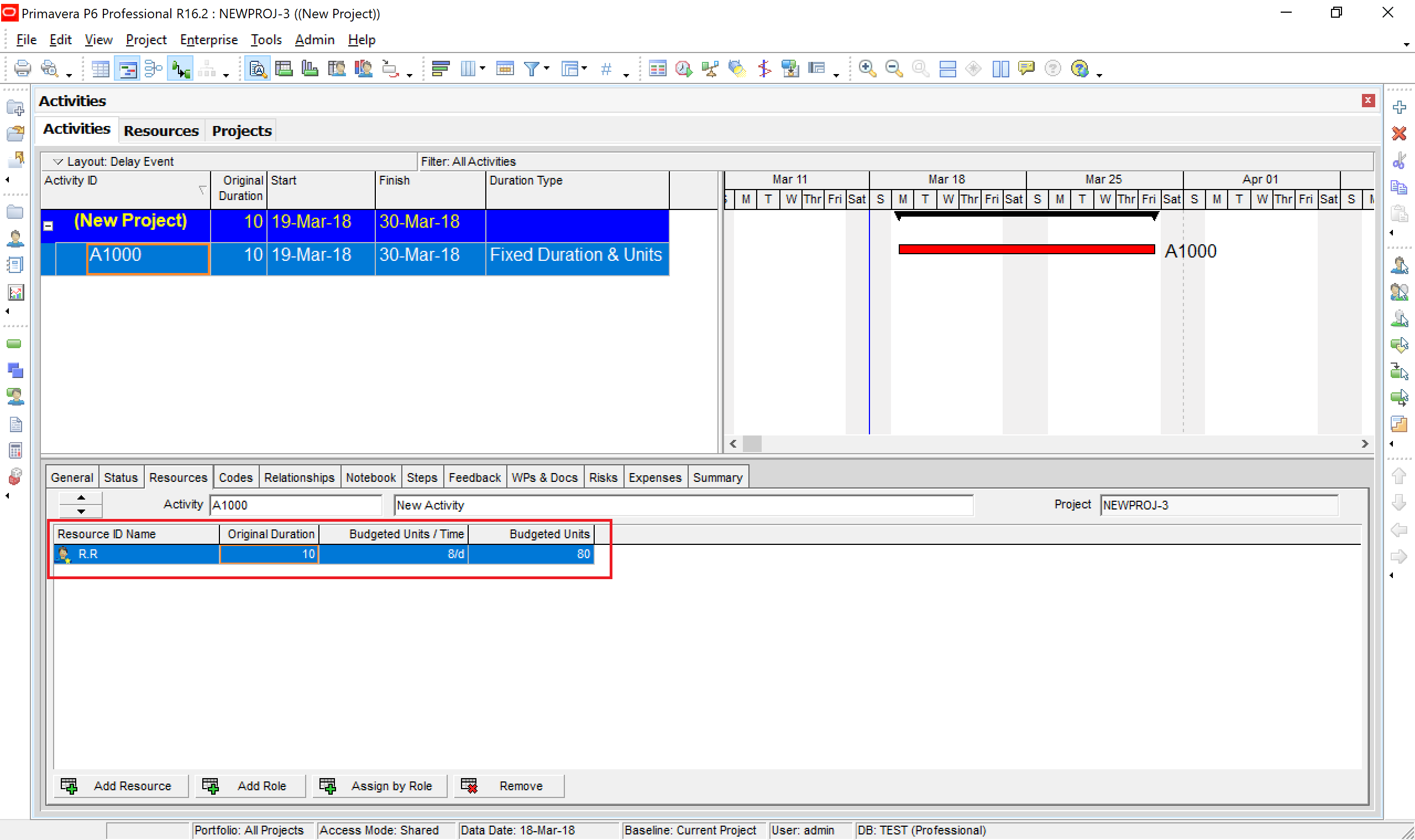

When you modify the duration of an activity, Primavera P6 must decide which value to adjust, Units/Time or Total Units, to keep the equation balanced.

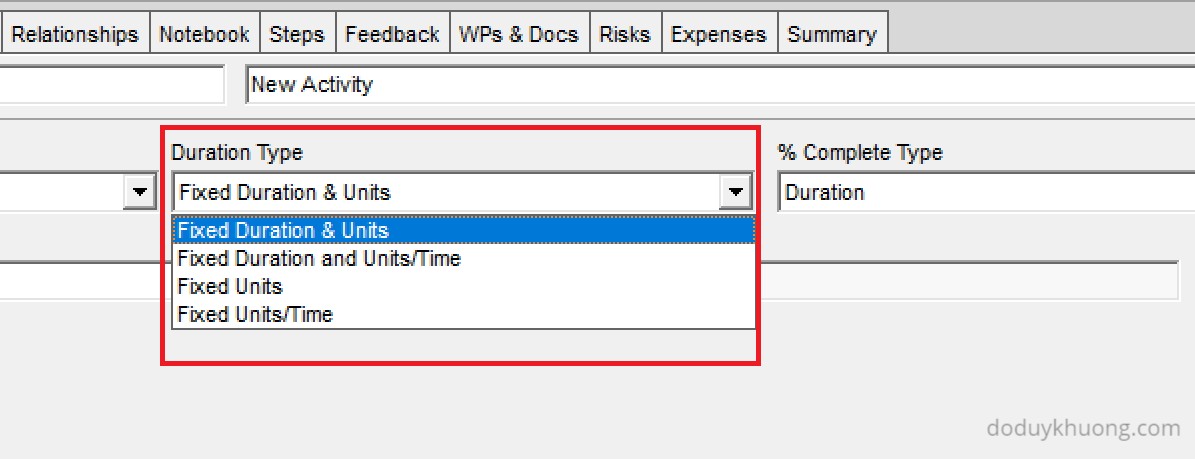

This is where Activity Duration Type comes into play.

The Duration Type setting in Primavera P6 determines which variable remains fixed and which ones are recalculated when changes are made.

Here’s a quick guide:

  • If Duration is fixed → P6 will not recalculate the duration.
  • If Duration is not fixed → P6 will recalculate the duration to maintain the equation.

Below is a summary of how each Duration Type affects the calculation:

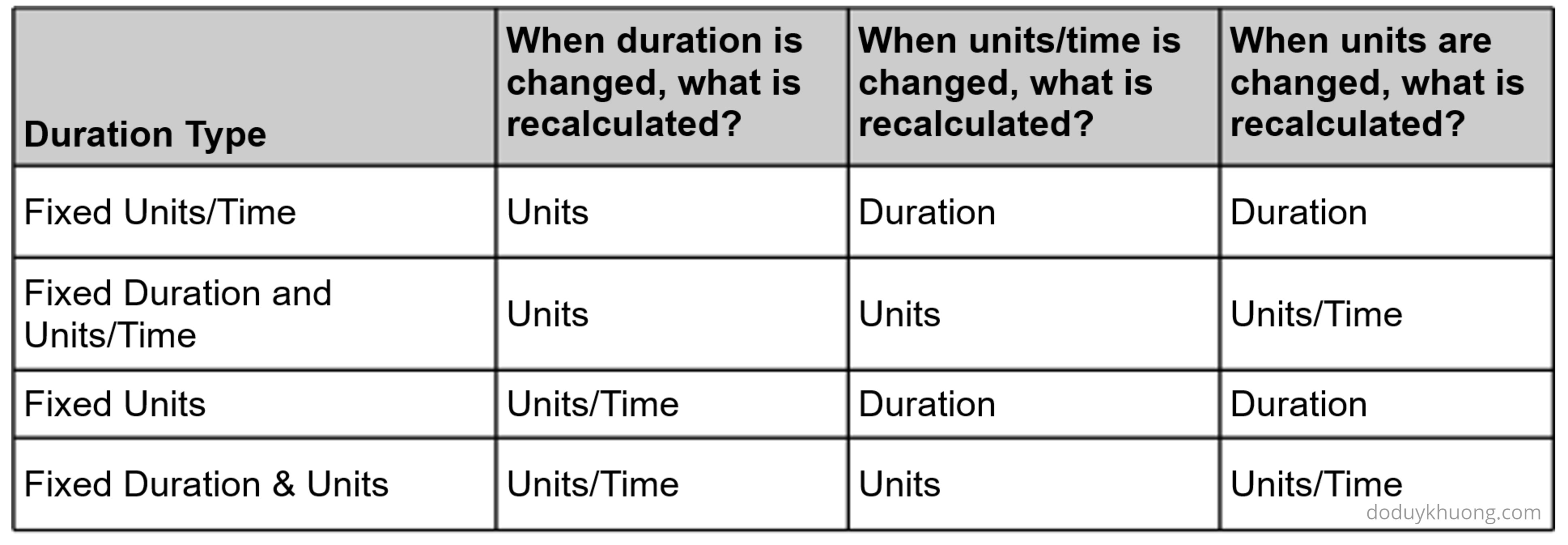

How to use Activity Duration Type in Primavera P6-1

Practice Exercise

To better understand how each Duration Type works, try filling in the values in the following tables so that the equation remains true for each scenario.



Duration Type: Fixed Units/Time

How to use Activity Duration Type in Primavera P6-2

Duration Type: Fixed Units

How to use Activity Duration Type in Primavera P6-3

Duration Type: Fixed Duration & Units

How to use Activity Duration Type in Primavera P6-4

Duration Type: Fixed Duration and Units/Time

How to use Activity Duration Type in Primavera P6-5

3 thoughts on “How to use Activity Duration Type in Primavera P6”

Add yours

  1. Thanks for Sharing this article, it’s really helpful.

    Can you also please share Your article for % Complete Type, and how does all go, while updating the Progress
