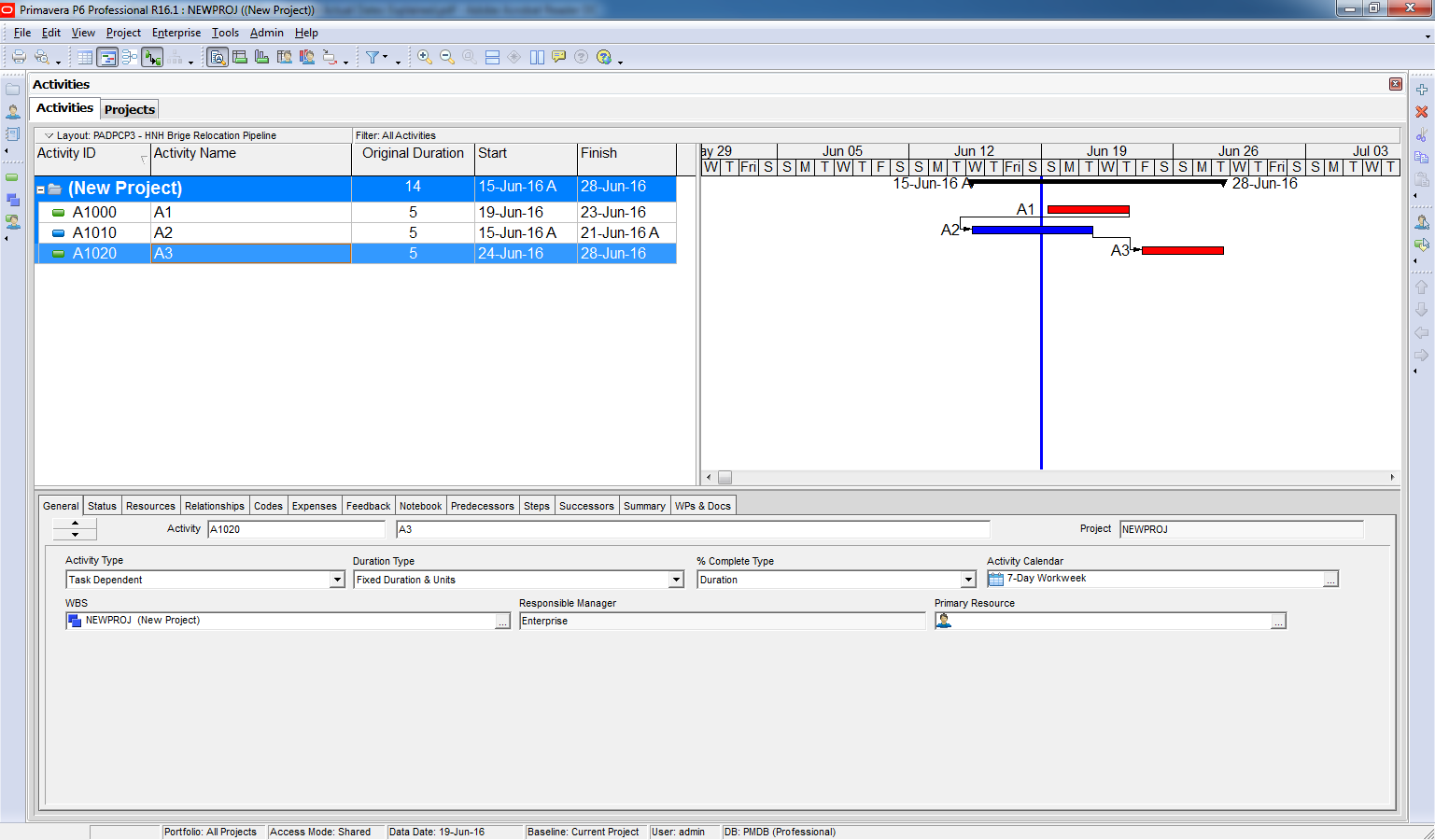

Primavera P6 provides three key options in the Scheduling Options dialog that control how the software handles Out-of-Sequence Progress:
- Retained Logic
- Progress Override
- Actual Dates
Understanding these options is essential for accurate schedule calculations. Let’s explore how each works with an example.

What is Out-of-Sequence Progress?
Out-of-sequence progress occurs when an activity starts or finishes before its predecessor is complete, violating the planned logic.

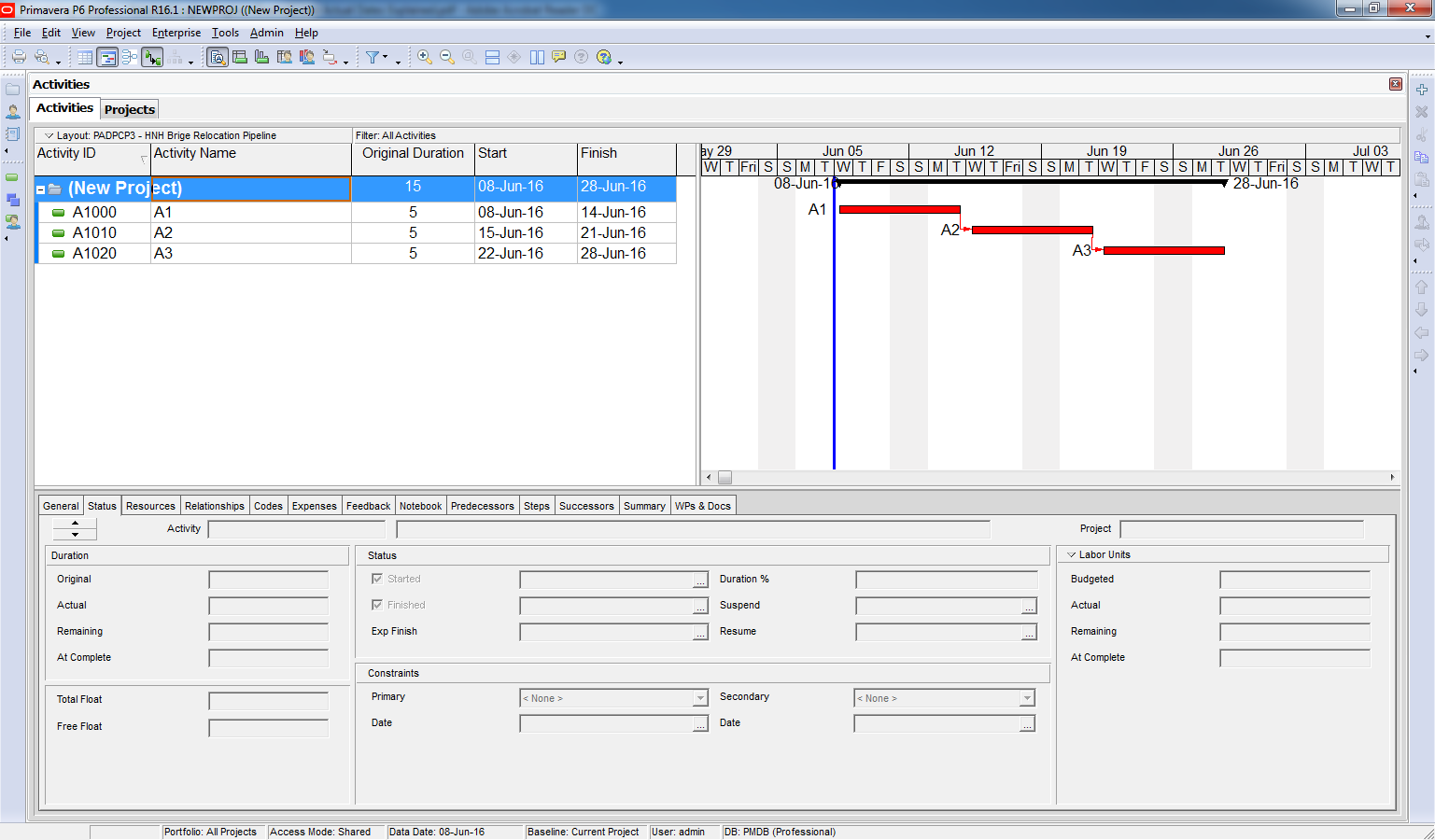

Example:

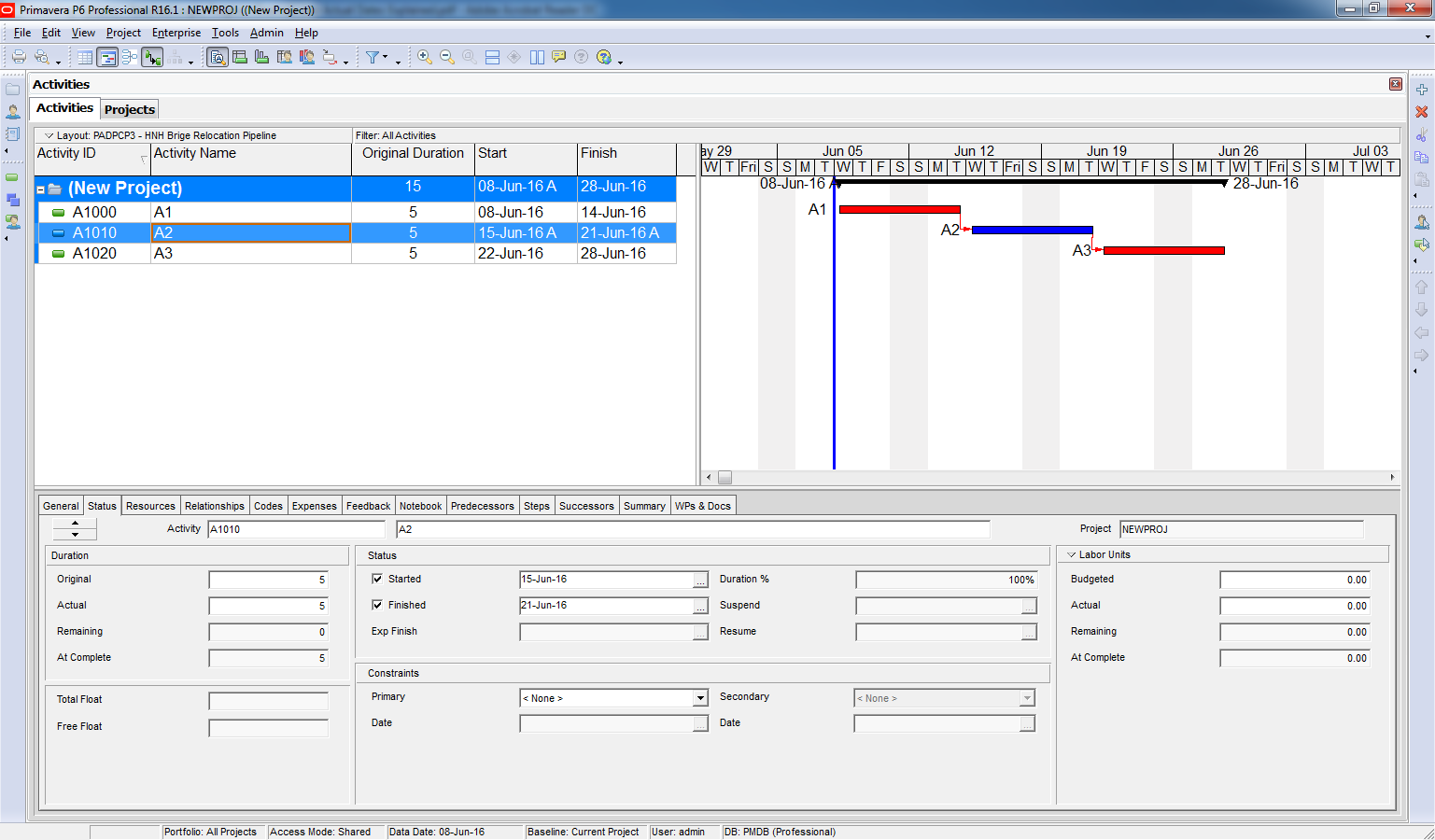

- Activity A2 should start after A1 finishes.
- In reality, A2 starts and finishes before A1 begins.


How does Primavera P6 deal with this situation?
It depends on which scheduling option was chosen.

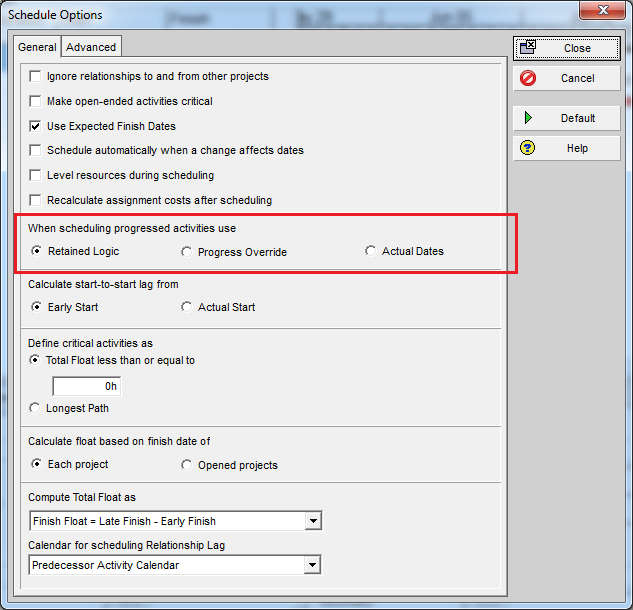

Scheduling Options Explained
1. Retained Logic
- Primavera retains the original logic.
- Even if A2 finishes early, A3 cannot start until A1 is complete.
- This enforces the original dependency chain.

2. Progress Override
- Primavera overrides the original logic.
- A3 is scheduled immediately after A2 finishes, ignoring A1’s dependency.
- A1 is no longer considered a predecessor for A3.

3. Actual Dates
- Primavera uses actual dates to drive the schedule.
- A3 starts as soon as A2 is complete, even if A2’s actual finish is after the data date.
- Logic is overridden by actual progress.

Key Differences
| Option | Behavior |
|---|---|
| Retained Logic | Keeps original logic; successor waits for all predecessors. |
| Progress Override | Ignores logic; successor starts after out-of-sequence activity. |
| Actual Dates | Uses actual dates; overrides logic based on real progress. |
Best Practice
- Use Retained Logic for strict dependency control (such as: when analyzing delays or performing forensic schedule analysis)
- Use Progress Override when real-world progress should drive the schedule.
- Use Actual Dates for generating reports for stakeholders that need to show what actually happened, regardless of the original logic.
