How to perform Collapsed As-Built / As-Built But-For Schedule Delay Analysis in Primavera P6

Introduction

An Collapsed As-Built / As-Built But-For Schedule Delay Analysis (ABBF) is a retrospective CPM schedule delay analysis technique that determines the earliest date that the required project completion activity, or various milestone activities could have been achieved but-for the owner-caused delays that occurred during the project. The amount of owner-caused delay determined from the ABBF Schedule Delay Analysis quantifies the contractor’s entitlement to receive compensable delay damages. Similarly, the analysis could determine the earliest date that the various completion activities could have been achieved but-for the contractor-caused noncompensable delays that occurred during the project.

The ABBF Schedule Delay Analysis is typically more difficult to perform than the Time Impacted Analysis because most CPM software programs regard as-built dates as  historical events fixed in time. As a result, most CPM software programs will not permit but-for analysis models to be run on schedule containing actual dates. Consequently, the as-built schedule must be converted to an as-planned format containing “planned” dates that correspond to the as-built schedule but are driven by logic and activity durations. This conversion step is used to create an As-Built Calculation Schedule that can collapse as delays are removed.

The ABBF Schedule Delay Analysis is performed by first removing owner-caused delays from the As-Built Calculation Schedule and recalculating the project completion date. Contractor-caused (noncompensable) and excusable (force majeure, acts of God…) delays are left in the As-Built Calculation Schedule. The As-Built Calculation Schedule with owner-caused delays removed is used to determine the compensable time period between the actual project completion date and the as-built but-for completion date.

Next, contractor-caused delays are removed from the original As-Built Calculation Schedule and the project completion date is recalculated. Owner-caused (compensable) and excusable (force majeure, acts of God…) delays are left in the As-Built Calculation Schedule. The ABBF Schedule Delay Analysis that removes contractor-caused delays is used to determine the time period between the actual completion date and the as-built but-for completion date for assessment of liquidated damages by the owner.

Why we need this method

It is a common misconception in the construction industry that if the contractor is entitled to an extension of time, then it is also automatically entitled to be compensated for the additional time that it has taken to complete the contract. It is usually not.

An additive delay analysis, such as the Time Impacted Analysis, by itself does not provide an answer to the issue of compensable delay. If a contractor incurs additional costs that are caused by both owner delay and concurrent contractor delay, then the contractor should only recover compensation to the extent it is able to separately identify the additional costs that were only caused by the owner delay. If it would have incurred the additional costs in any event as a result of concurrent contractor-caused delays, the contractor will not be entitled to recover those additional costs unless provided otherwise in the contract. Therefore, the ABBF Schedule Delay Analysis is often performed to address the issue of compensable delay net of concurrent contractor-caused delay on the as-built schedule, which the Time Impated Analysis do not analyze properly.

How to perform Collapsed As-Built, As-Built But-For Schedule Delay Analysis in Primavera P6-14
Source: As-Built But-For Schedule Delay Analysis – Richard J. Long, P.E. – Long International, Inc.

Demonstration Using a Simple House Project

To illustrate this method, we use a basic house construction project.

1. As-Planned Schedule

The original schedule (As-Planned) shows a total project duration of 40 days.

How to perform Collapsed As-Built, As-Built But-For Schedule Delay Analysis in Primavera P6-1

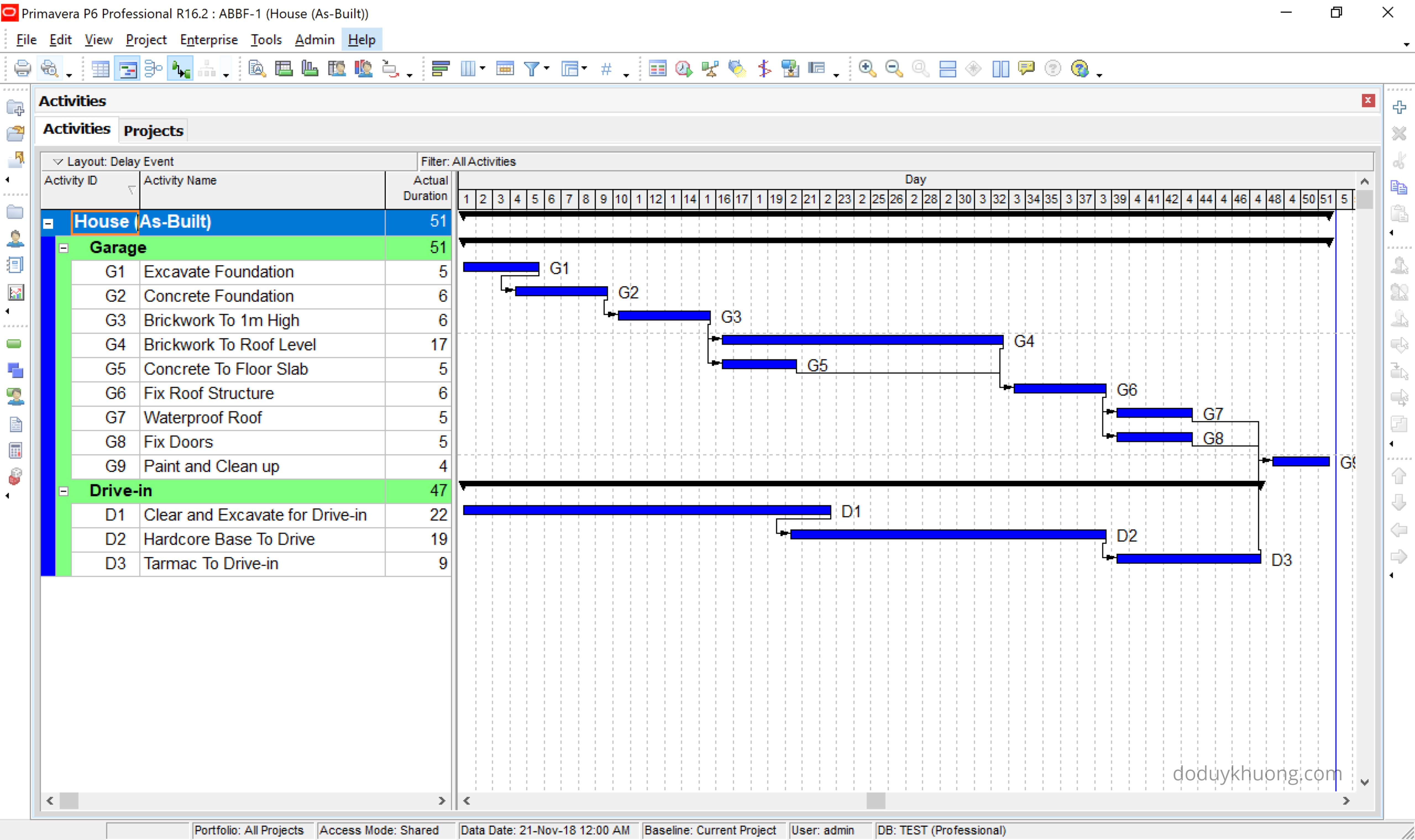

2. As-Built Schedule

Upon project completion, the actual duration was 51 days.

How to perform Collapsed As-Built, As-Built But-For Schedule Delay Analysis in Primavera P6-2

This As-Built schedule already included all delay events which is documented in below table:

How to perform Collapsed As-Built, As-Built But-For Schedule Delay Analysis in Primavera P6-3
Source: Construction Delay Analysis Technique – A Review of Application Issues and Improvement Needs – Nuhu Braimah

Type of Delay:

  • NN (Nonexcusable–Noncompensable): Contractor-caused delay
  • EC (Excusable Compensable): Owner-caused delay

3. Create As-Built Calculation Schedule

Create another As-Planned schedule which has Start/Finish date look like As-Built schedule. This schedule is called “As-Built Calculation Schedule”

Separate delay events to a different project so that later we can exclude them.

We created 1 project (As-Built Calculation Schedule) and 2 projects (contain Owner-caused delay and Contractor-caused delay):

How to perform Collapsed As-Built, As-Built But-For Schedule Delay Analysis in Primavera P6-4

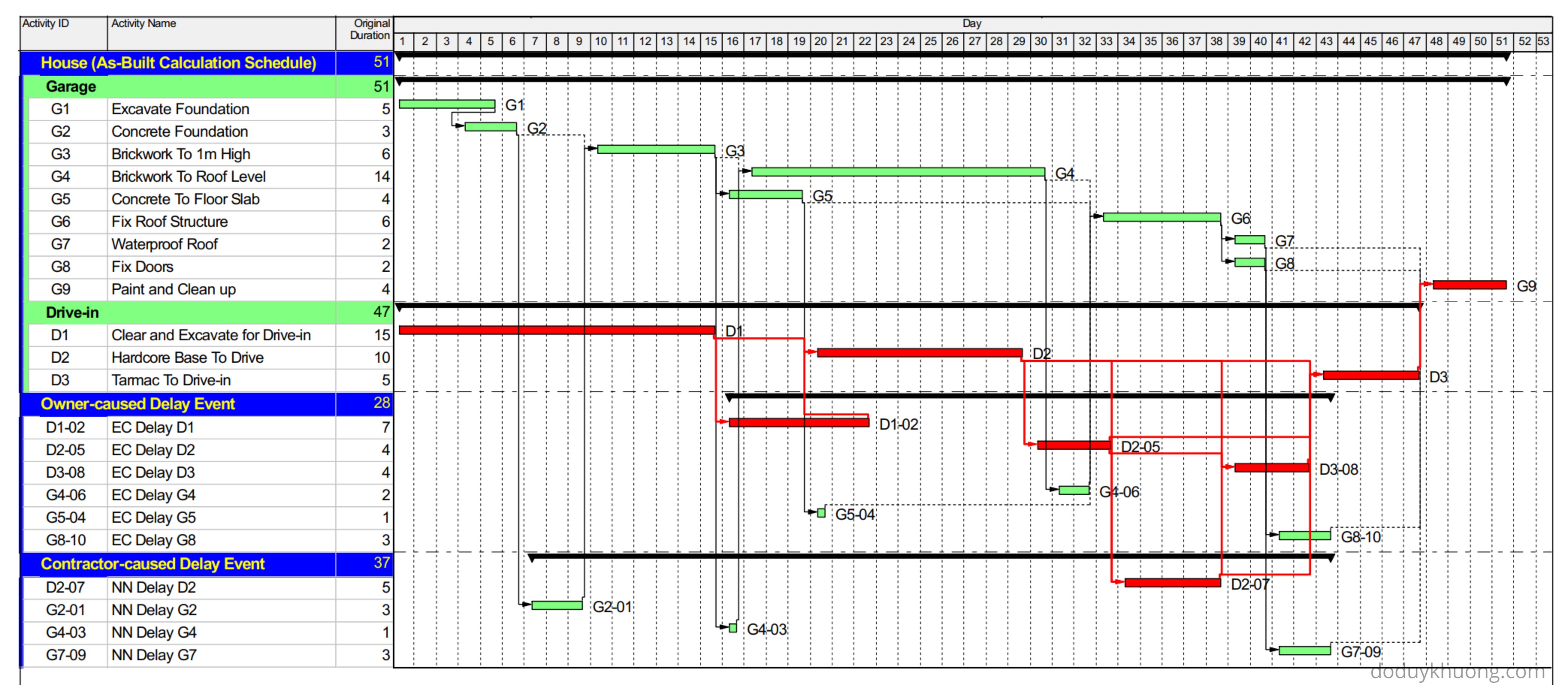

Opening 3 projects we have this schedule:

How to perform Collapsed As-Built, As-Built But-For Schedule Delay Analysis in Primavera P6-8

Using Activity Code function to put delay event next to activity, we have this view:

How to perform Collapsed As-Built, As-Built But-For Schedule Delay Analysis in Primavera P6-9

We can see that Start/Finish date (of each activity and whole project) and relationship of As-Built Calculation Schedule now look exactly the same with As-Built schedule.

Create Collapsed As-Built report

Contractor’s point of view (As-Built But For Owner):

Under this, all owner-caused delays were subtracted from the As-Built Calculation Schedule.

We open 2 projects: “House (As-Built Calculation Schedule)” and “Contractor-caused Delay Event”

How to perform Collapsed As-Built, As-Built But-For Schedule Delay Analysis in Primavera P6-10

Reschedule then we have this report:

How to perform Collapsed As-Built, As-Built But-For Schedule Delay Analysis in Primavera P6-11

The collapsed as-built schedule has completion date as day 45.

With actual completion date as day 51, the owner is responsible for 6 days (51–45) of the  project delay, which could be charged as compensable delay.

With original (baseline) completion date as day 40, the contractor is responsible for 5 days (45–40) of the  project delay.

Owner’s point of view (As-Built But For Contractor):

Under this, all contractor-caused delays were subtracted from the As-Built Calculation Schedule.

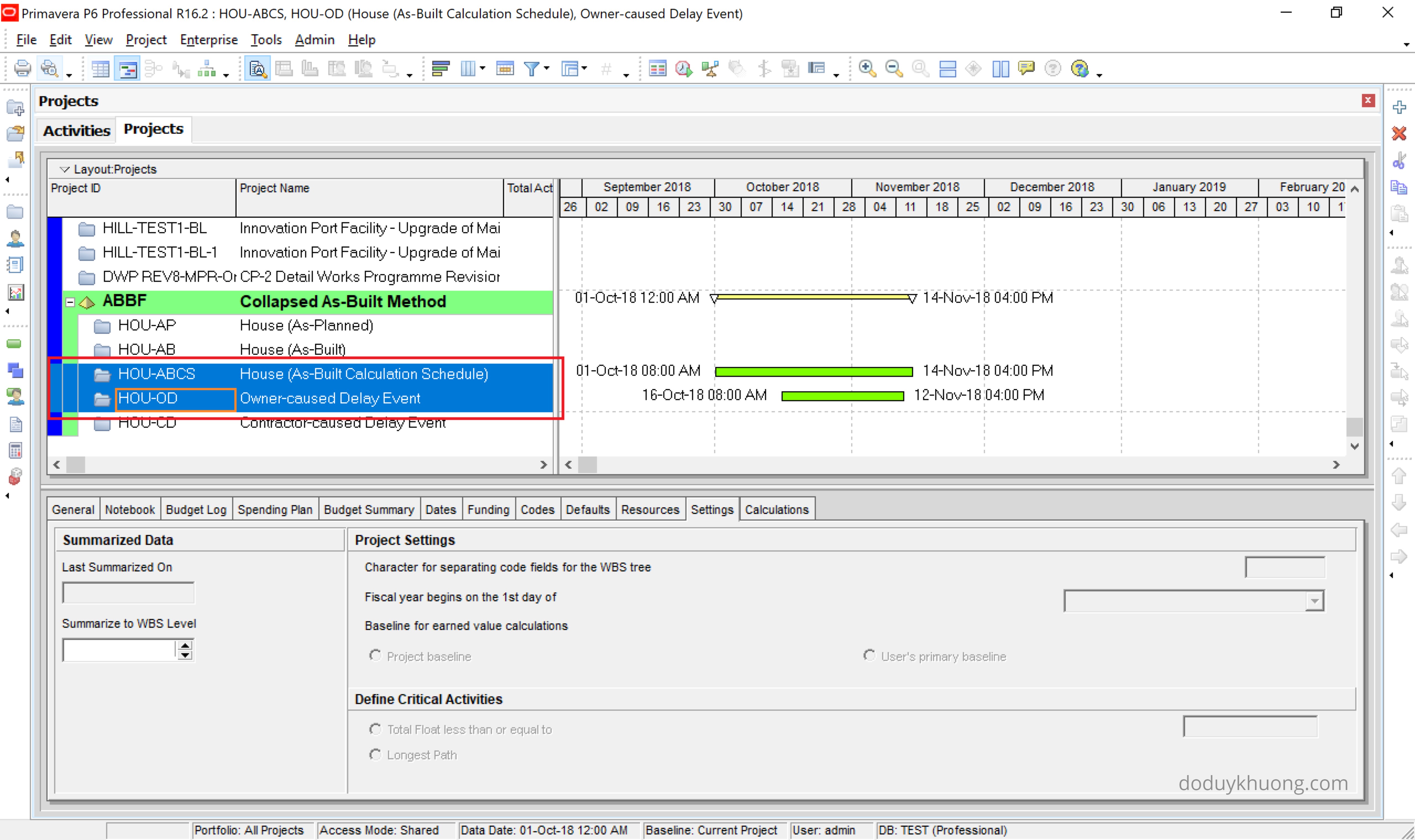

We open 2 projects: “House (As-Built Calculation Schedule)” and “Owner-caused Delay Event”

How to perform Collapsed As-Built, As-Built But-For Schedule Delay Analysis in Primavera P6-12

Reschedule then we have this report:

How to perform Collapsed As-Built, As-Built But-For Schedule Delay Analysis in Primavera P6-13

The collapsed as-built schedule has completion date as day 46.

With actual completion date as day 51, the contractor is responsible for 5 days (51–46) of the project delay, which could be charged for liquidated damages.

With original (baseline) completion date as day 40, the owner is responsible for 6 days (46–40) of the  project delay.

References:

  • The project data and delay events is taken from “Construction Delay Analysis Technique —A Review of Application Issues and Improvement Needs” – Nuhu Braimah
  • As-Built But-For Schedule Delay Analysis – Richard J. Long, P.E. – Long International, Inc.
