How does Resource Shift Calendar in Primavera P6 work?

In the Resources window under the Units & Prices tab, you’ll find a field called Shift Calendar. What does it do? Let’s explore.

How does Resource Shift Calendar in Primavera P6 work - 1

Purpose of the Shift Calendar

The Shift Calendar controls the Price/Unit for a resource based on the time an activity starts and finishes. This is useful when a resource has different rates for different shifts.

Example Scenario

Suppose Resource B works in a 3-shift operation with different hourly rates:

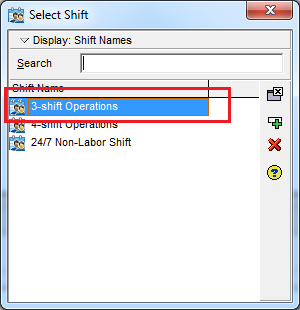

  1. In the Shift Calendar field, select 3-Shift Operations.
  2. Define rates for each shift:
    • Shift 1: $15/hour
    • Shift 2: $10/hour
    • Shift 3: $13/hour

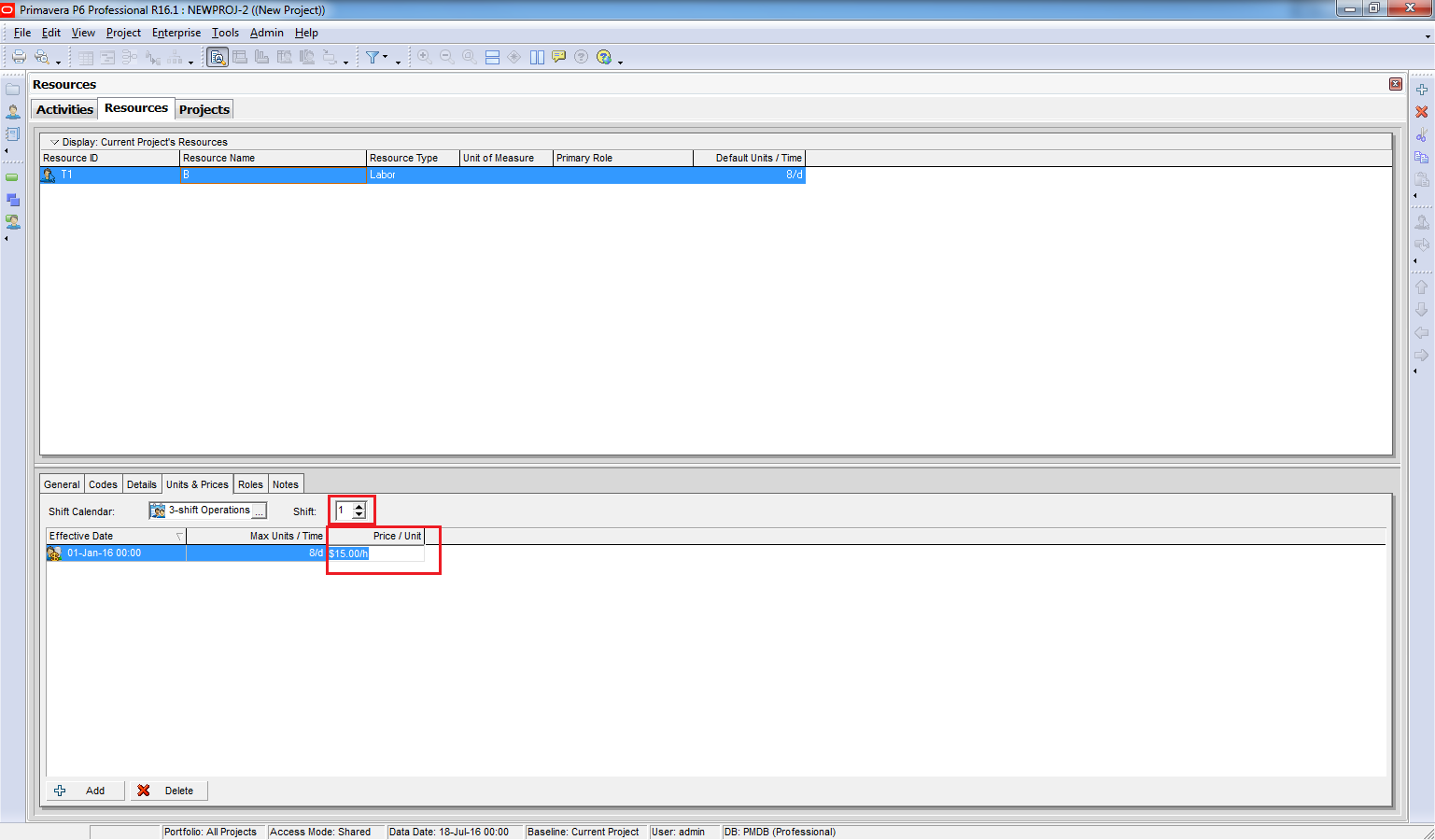

How does Resource Shift Calendar in Primavera P6 work - 13

How does Resource Shift Calendar in Primavera P6 work - 2

Shift 1: 15 $/hour

How does Resource Shift Calendar in Primavera P6 work - 3

Shift 2: 10 $/hour

How does Resource Shift Calendar in Primavera P6 work - 4

Shift 3: 13 $/hour

How does Resource Shift Calendar in Primavera P6 work - 5

Check Shift Timings

To see shift start and end times:

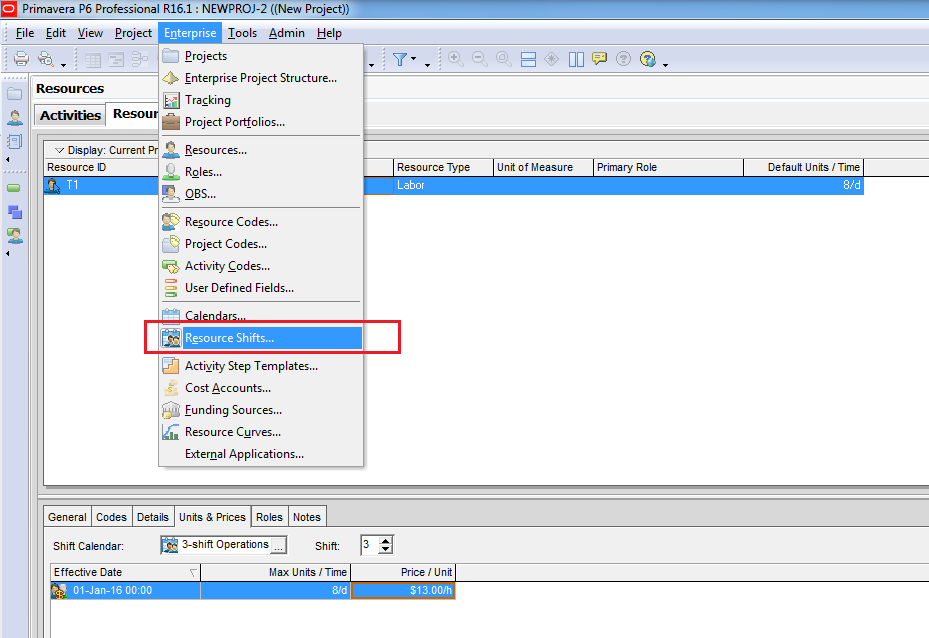

  • Go to Enterprise → Resource Shift.
  • Select 3-Shift Operations and click Modify.

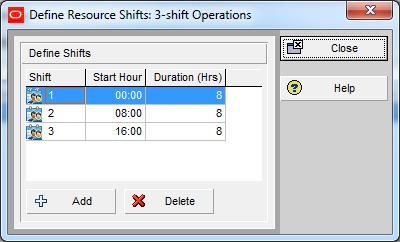

  • You’ll see:
    • Shift 1: 00:00 – 08:00
    • Shift 2: 08:00 – 16:00
    • Shift 3: 16:00 – 00:00

How does Resource Shift Calendar in Primavera P6 work - 6

Select 3-shift Operations and click Modify

How does Resource Shift Calendar in Primavera P6 work - 7

Now we can see :

  • Shift 1 start at 00:00, finish at 08:00
  • Shift 2 start at 08:00, finish at 16:00
  • Shift 3 start at 16:00, finish at 00:00
How does Resource Shift Calendar in Primavera P6 work - 8

Apply to Activities

Now, let’s create three activities:

  • Each activity has 1-day duration (8 hours).
  • Calendar: 7-Day Workweek (24 hours/day).
  • Assign Resource B to all activities.
How does Resource Shift Calendar in Primavera P6 work - 9

Because each activity starts at a different time, Primavera applies the correct rate:

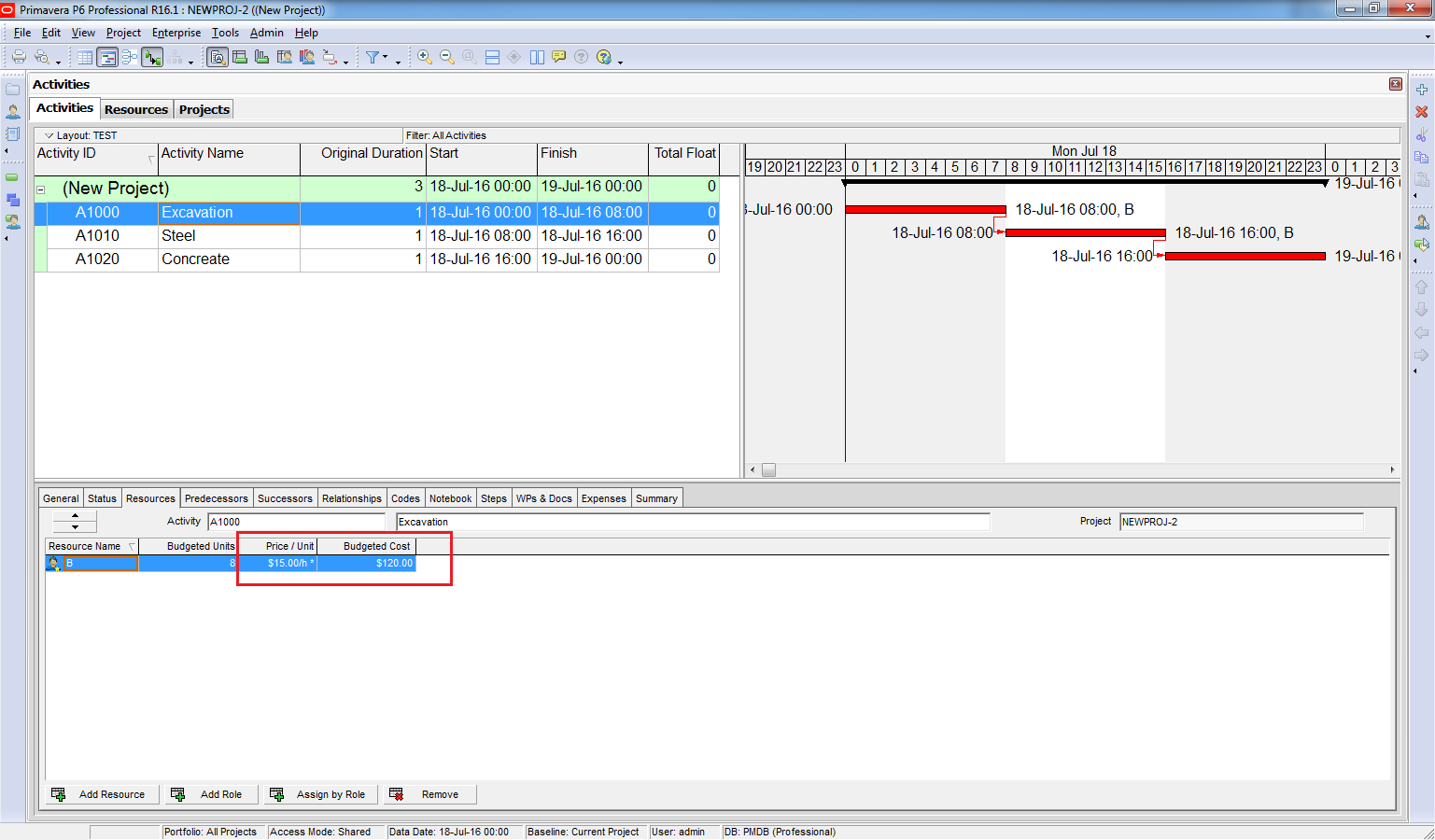

  • Excavation: 00:00 – 08:00 → $15/hour (Shift 1)
  • Steel: 08:00 – 16:00 → $10/hour (Shift 2)
  • Concrete: 16:00 – 00:00 → $13/hour (Shift 3)

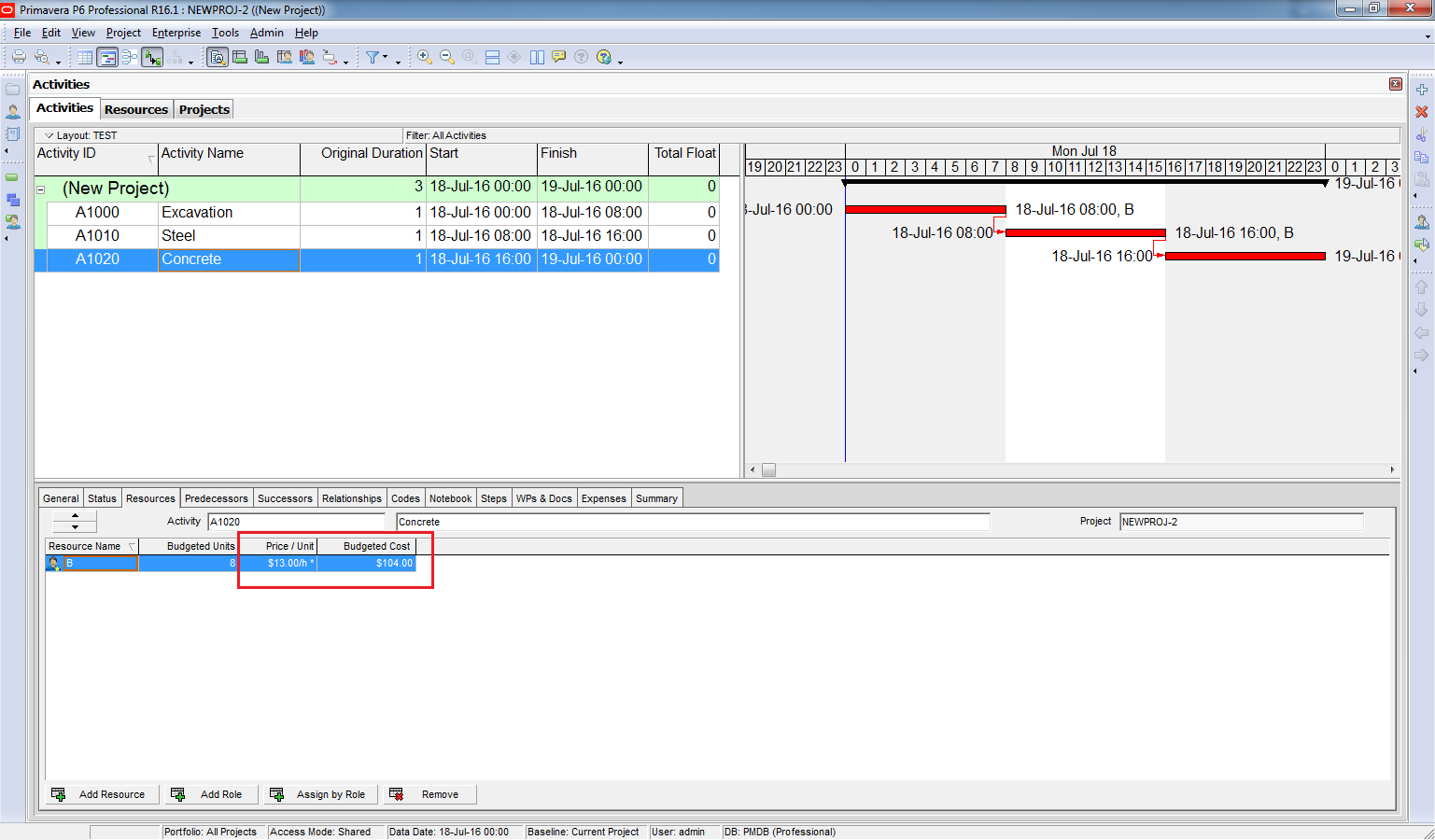

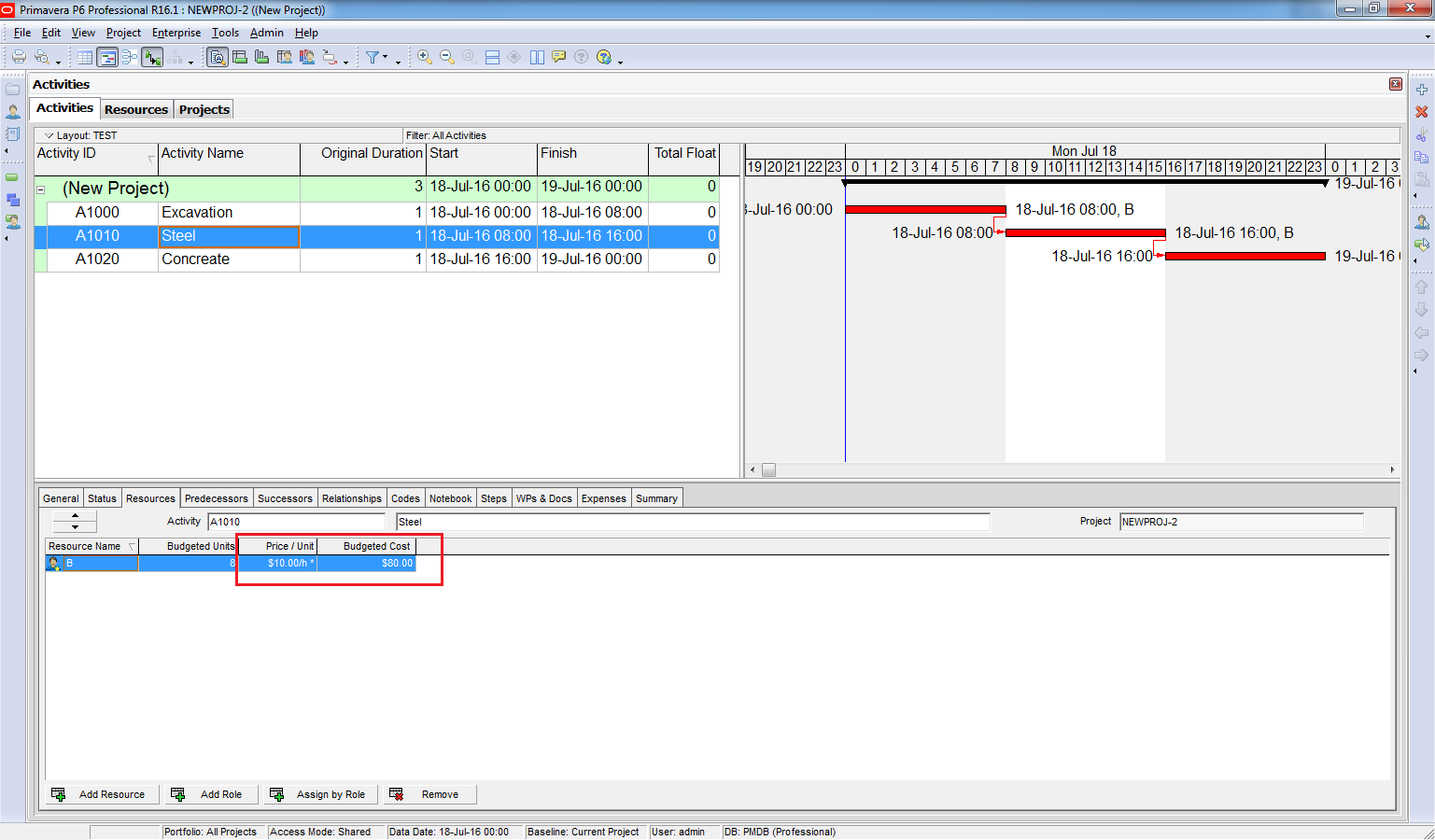

How does Resource Shift Calendar in Primavera P6 work - 10

How does Resource Shift Calendar in Primavera P6 work - 11

How does Resource Shift Calendar in Primavera P6 work - 12

Conclusion

Primavera automatically calculates resource costs based on the shift in which the activity occurs. This ensures accurate cost planning for projects with multiple shifts and varying labor rates.
