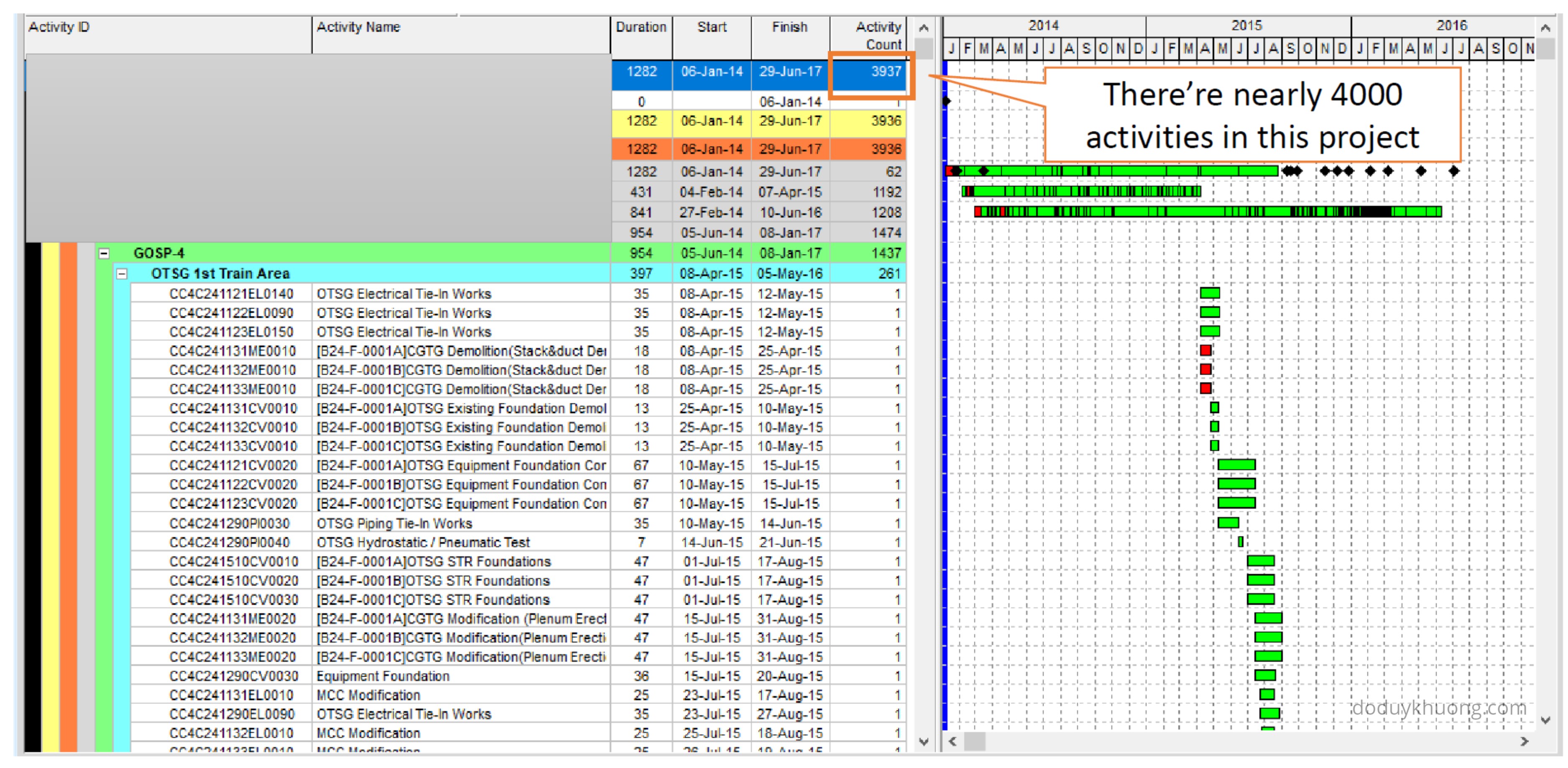

Primavera P6 software can be very useful in delay analysis work. Some of the benefits are described as follows.
1. Filter which activity affect the critical milestones
There could be many delay events happened in a project and each delay event affects certain activities.
What are the delay events or activities impacting the critical milestones?

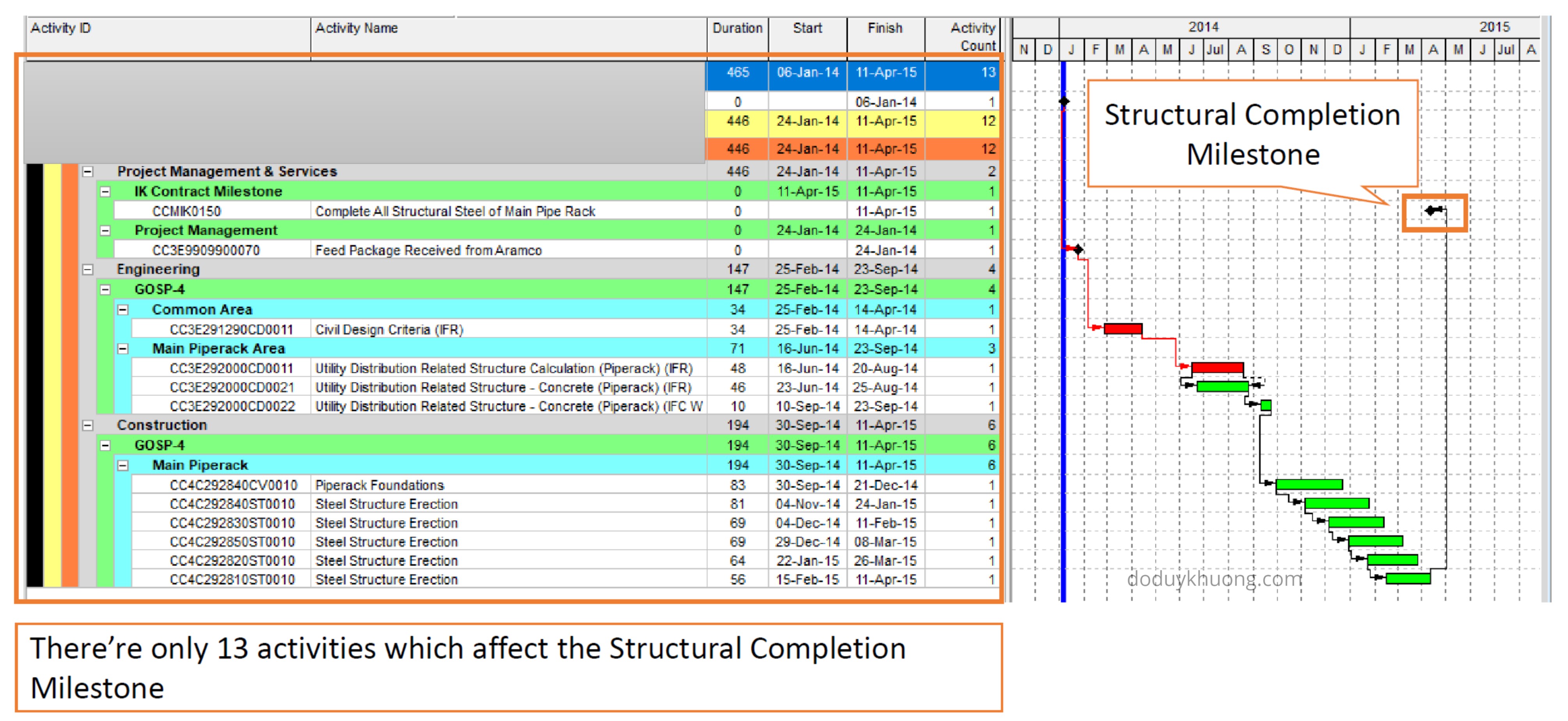

- Primavera P6 can easily identify the activities affecting a certain milestone.

- Primavera P6 can easily identify the activities affecting the project completion date.
Then we can trace the delay event relating to those activities.
2. Compare the Impacted Schedule with the Baseline
How many day is the project delayed in comparison with the Baseline?

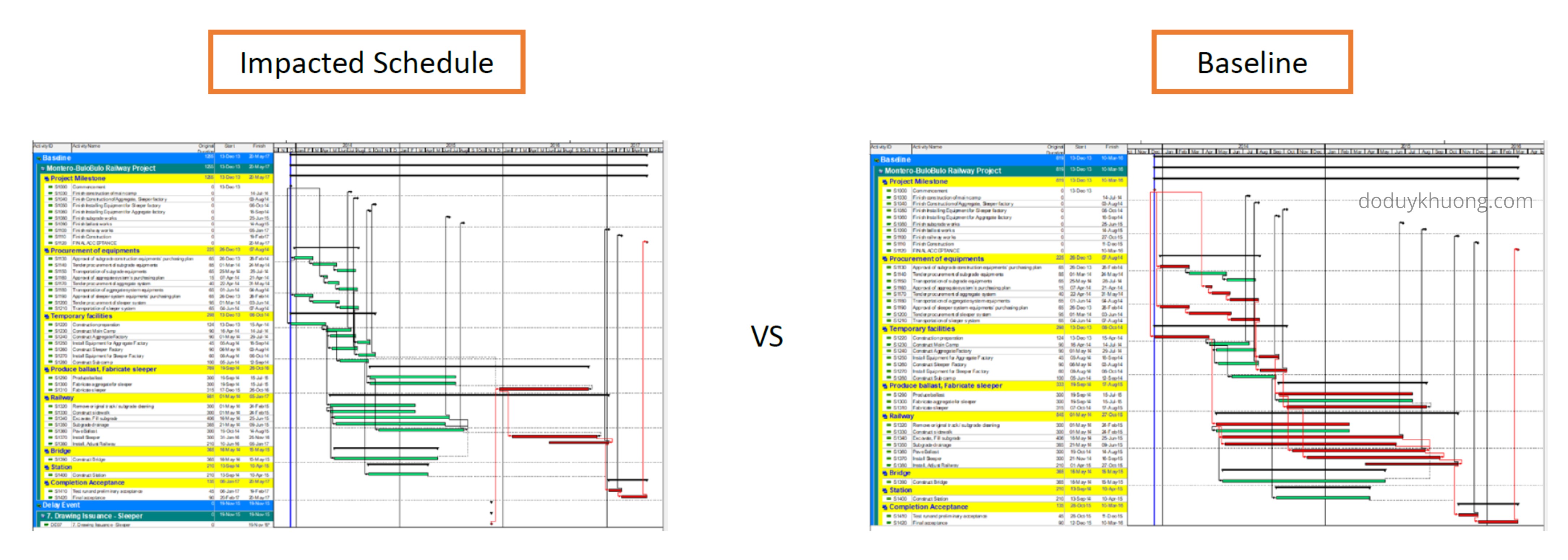

Primavera P6 can produce a report to compare the Impacted Schedule with the Baseline.

In the gantt chart in the picture above, each activity has 2 bars. The yellow bars represent the Baseline and the green / red bar represent the Impacted Schedule. The idea is illustrated in the picture below.

3. Present an individual effect of one delay event or a combined effect of several delay events

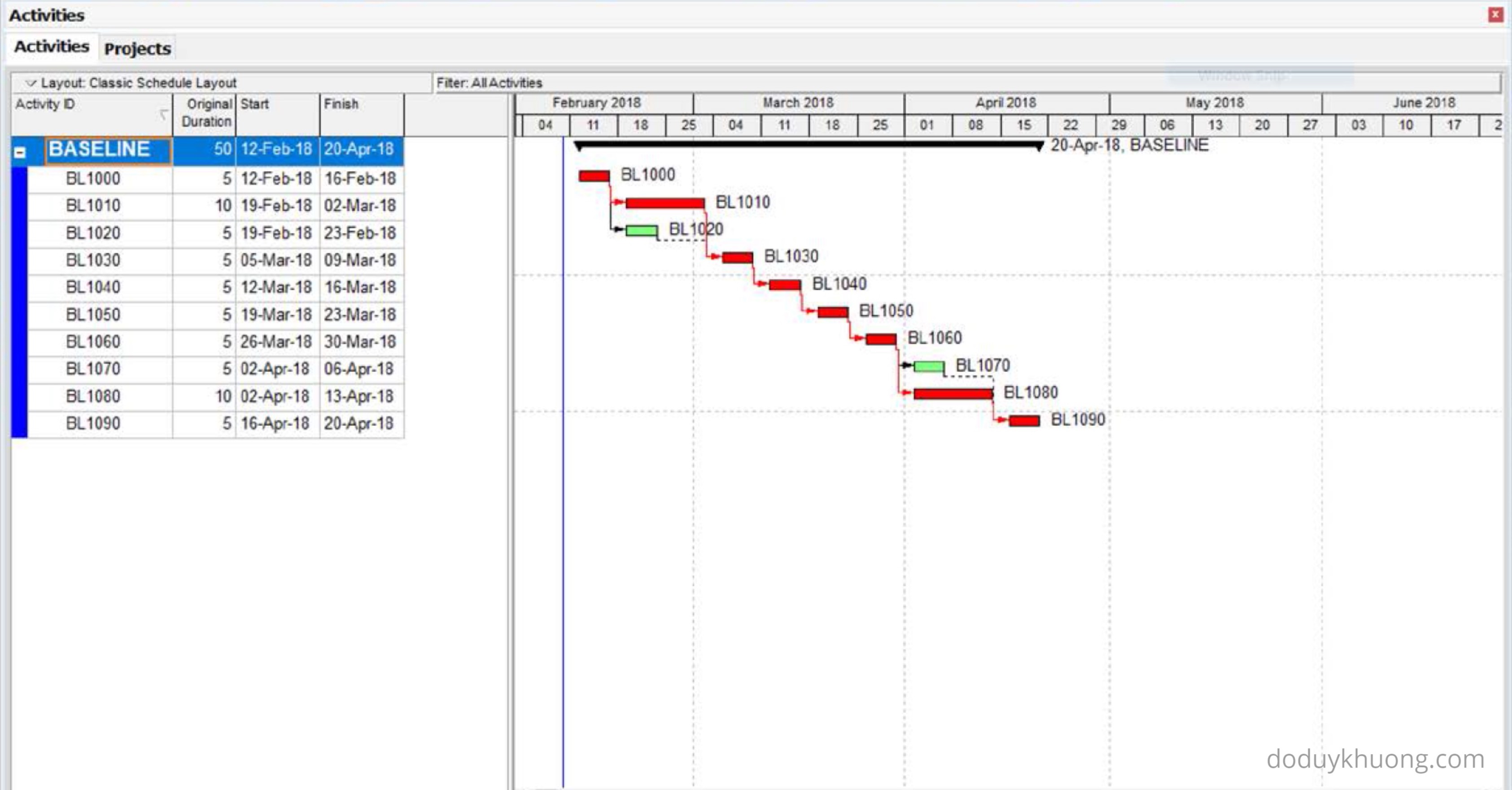

Let’s look at a simple project illustrated in the picture below.

There were five delay events occurred during the course of the project.
How can we see the effect of each delay event and the combined effect of several delay events?
Primavera P6 can present the effect of the delay events in the following scenarios:

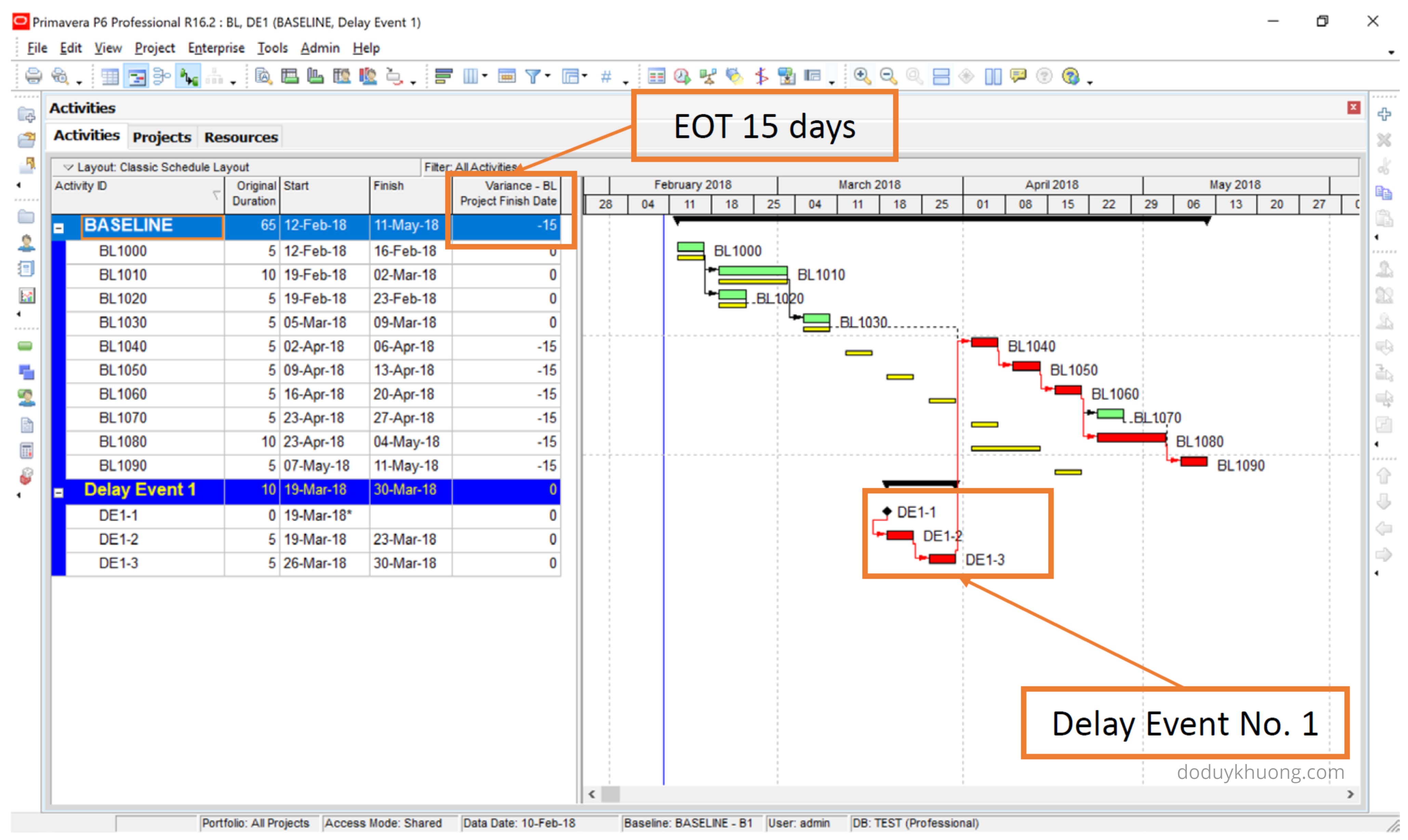

- The individual effect of delay event No. 1

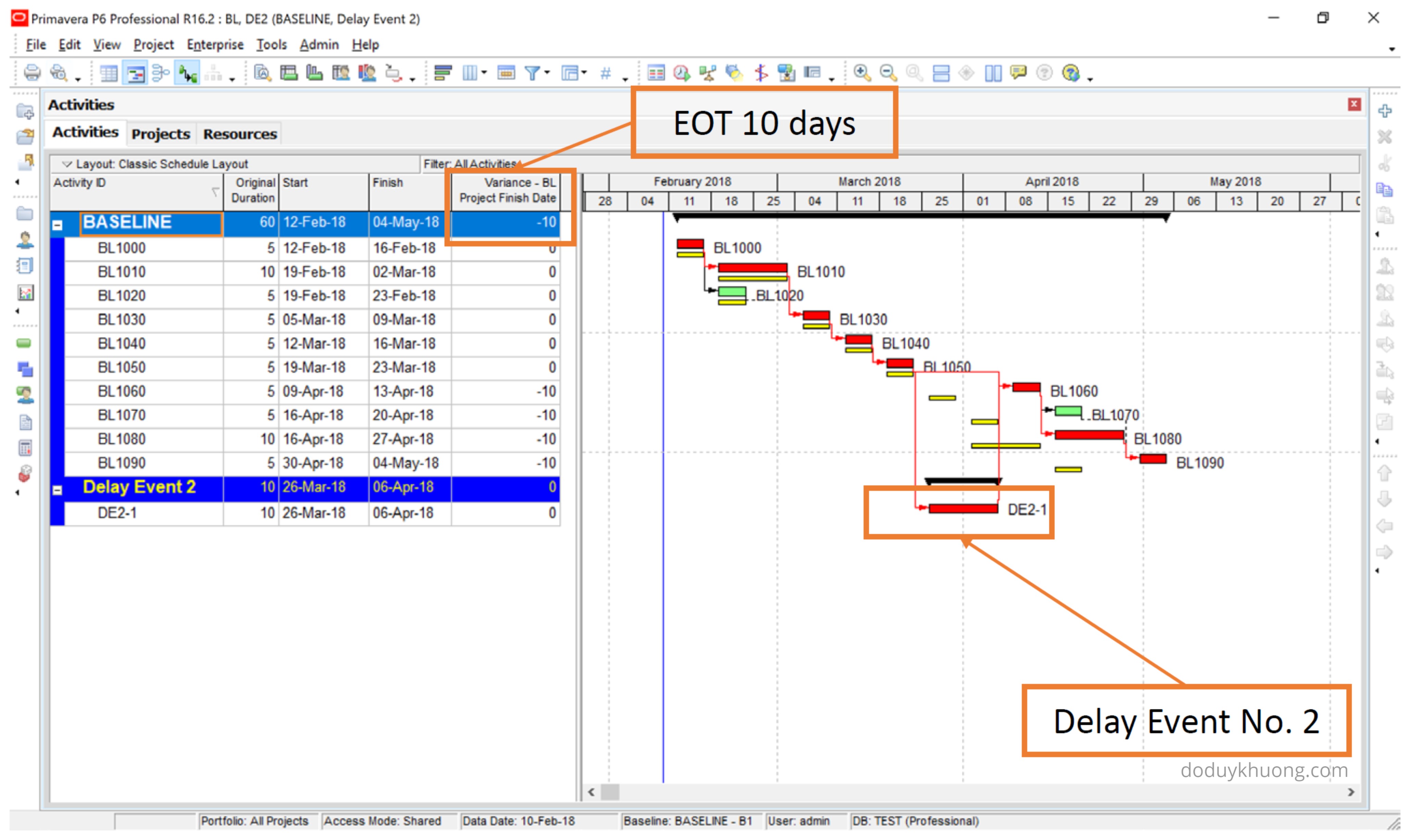

- The individual effect of delay event No. 2

- The combined effect of Delay Event No. 1 and No. 2

- The combined effect of all of the delay events

I am trying to do a Time Impact study on a P6 project that was very poorly put together and impacts were not tied to any particular activities. Now at the end of the project the G.C. is trying to be compensated by the owner for delays by the owner that have extended the completion date. Is there any method to attack this or is it a waste of time?
